WP4 Impact & Sustainability Overview UPDATE OF THE
Author : celsa-spraggs | Published Date : 2025-06-27
Description: WP4 Impact Sustainability Overview UPDATE OF THE PROGRESS MADE UP TO NOVEMBER 2022 1 05 December 2022 FCCIS Workshop Emanuela Sirtori CSIL Space for additional logos WP4 structure objective tasks team 2 Space for additional logos
Presentation Embed Code
Download Presentation
Download
Presentation The PPT/PDF document
"WP4 Impact & Sustainability Overview UPDATE OF THE" is the property of its rightful owner.
Permission is granted to download and print the materials on this website for personal, non-commercial use only,
and to display it on your personal computer provided you do not modify the materials and that you retain all
copyright notices contained in the materials. By downloading content from our website, you accept the terms of
this agreement.
Transcript:WP4 Impact & Sustainability Overview UPDATE OF THE:

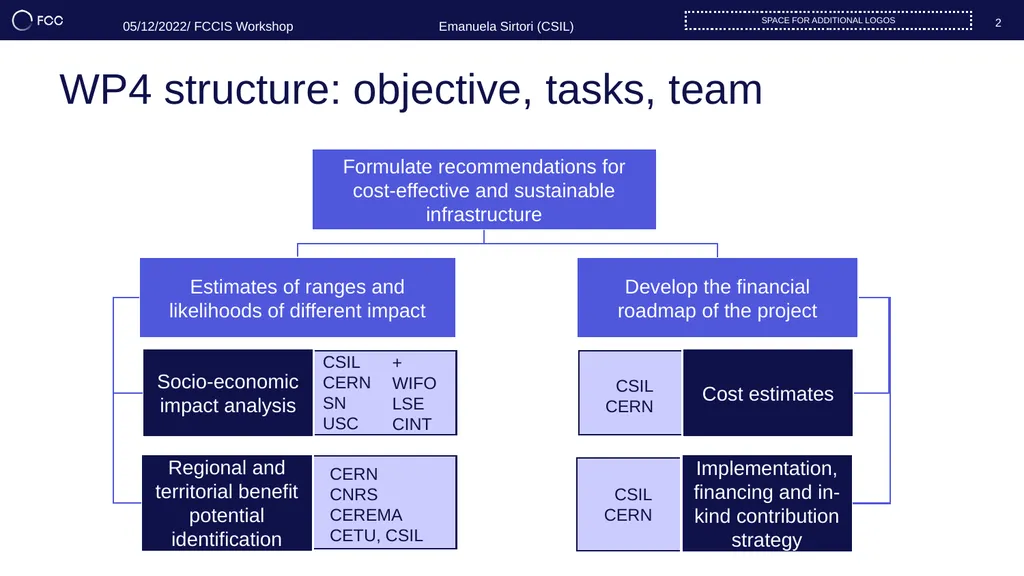

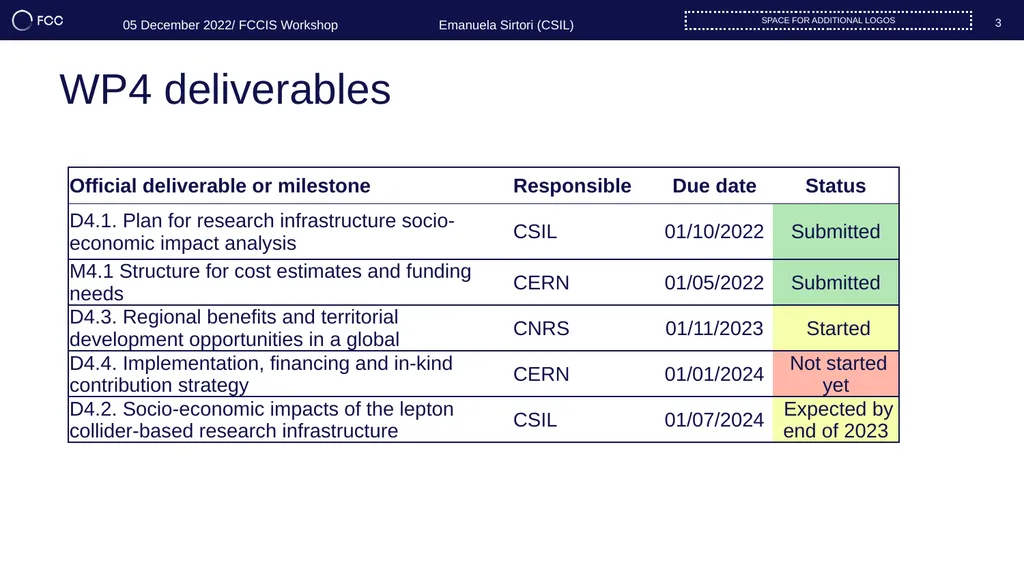

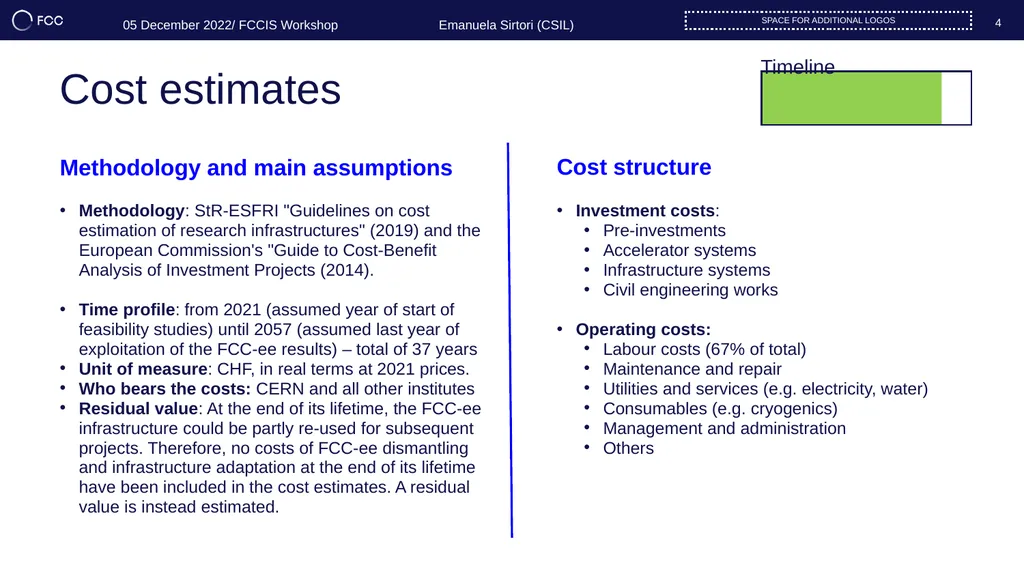

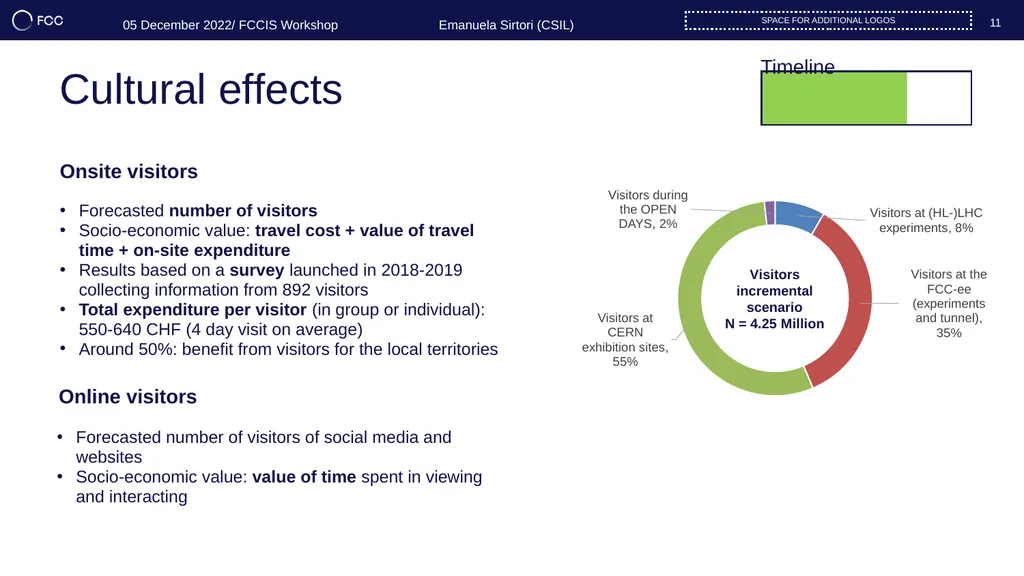

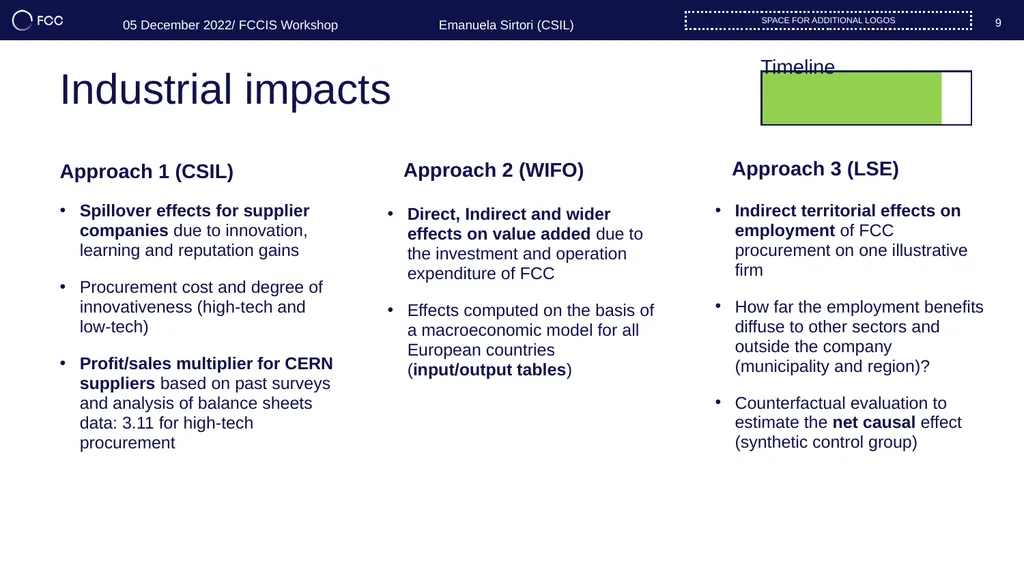

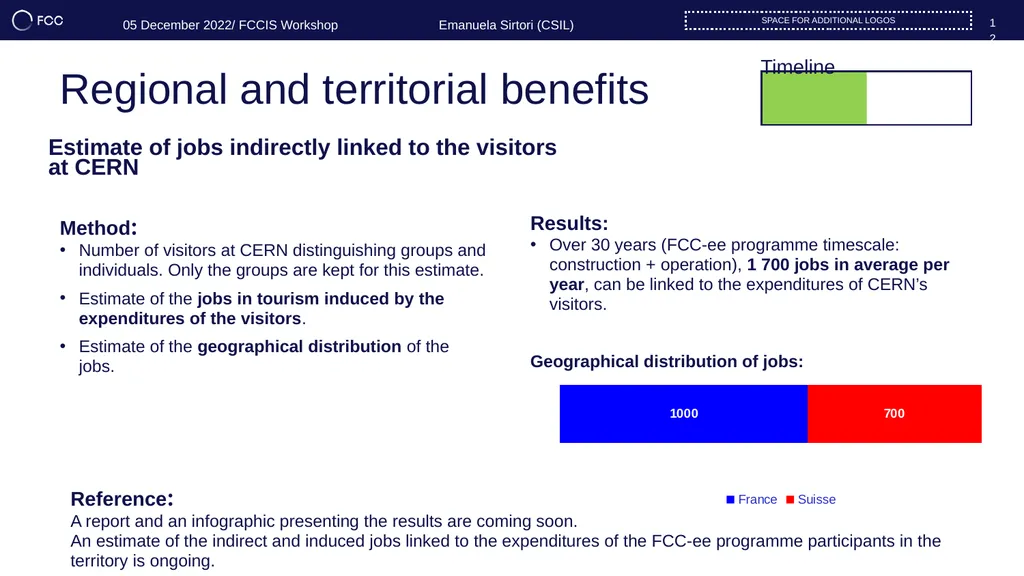

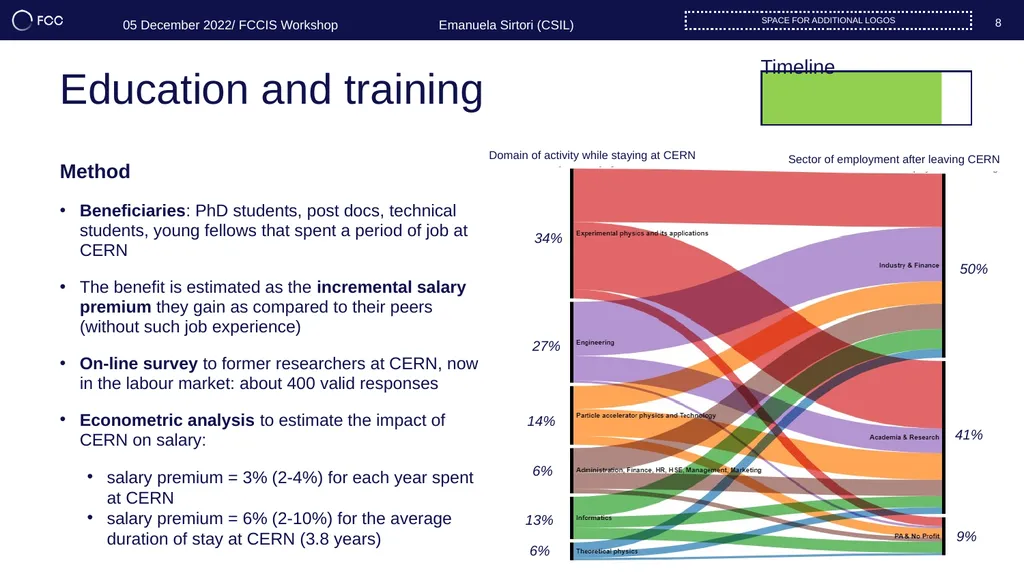

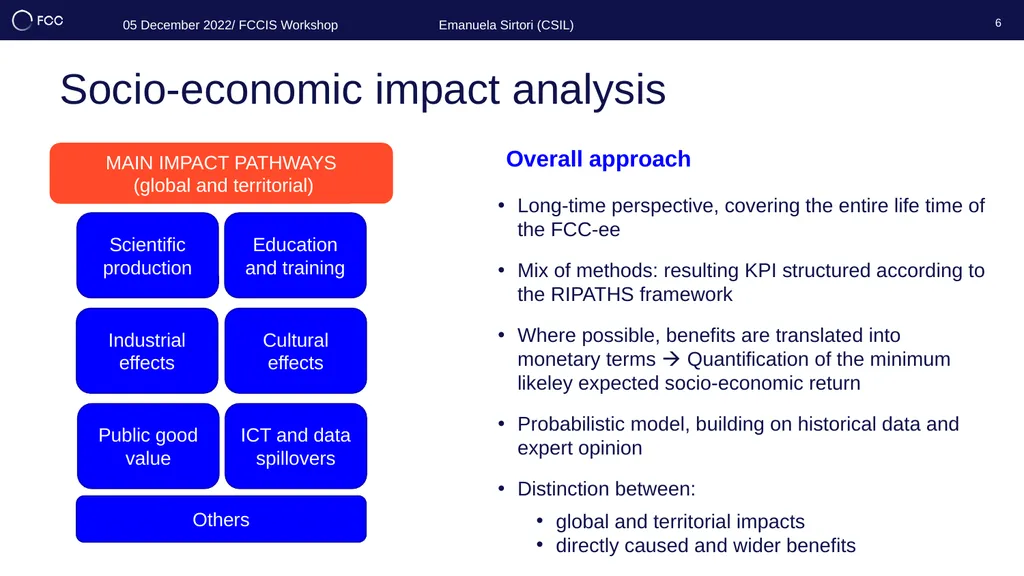

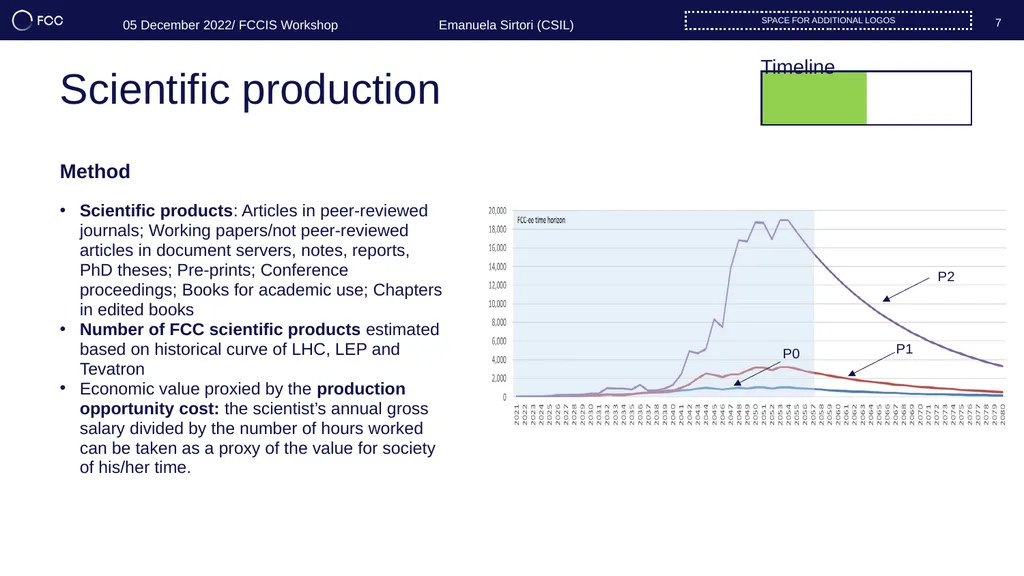

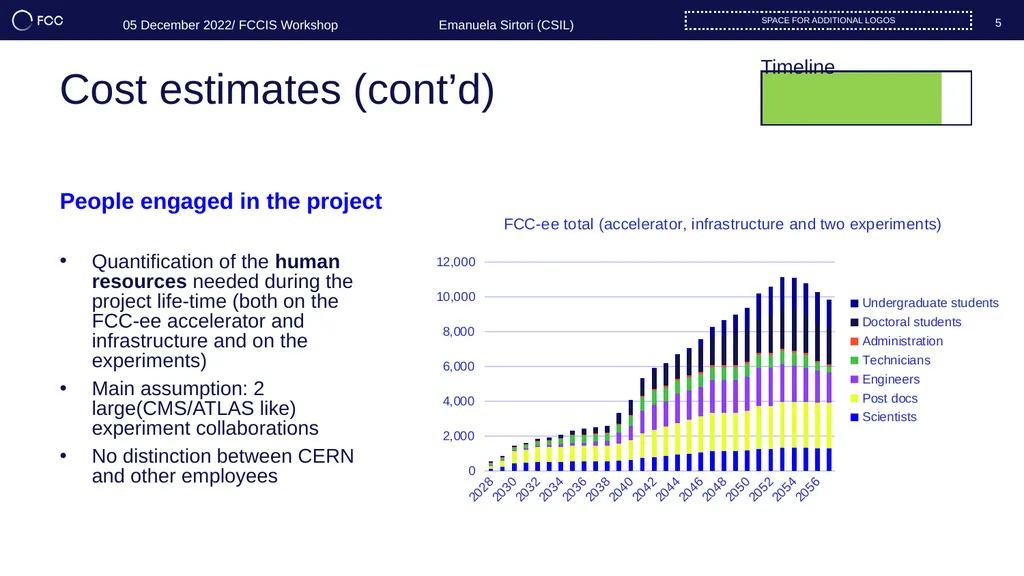

WP4 Impact & Sustainability Overview UPDATE OF THE PROGRESS MADE UP TO NOVEMBER 2022 1 05 December 2022/ FCCIS Workshop Emanuela Sirtori (CSIL) Space for additional logos WP4 structure: objective, tasks, team 2 Space for additional logos Emanuela Sirtori (CSIL) 05/12/2022/ FCCIS Workshop Cost estimates Implementation, financing and in-kind contribution strategy Socio-economic impact analysis Regional and territorial benefit potential identification Estimates of ranges and likelihoods of different impact Develop the financial roadmap of the project Formulate recommendations for cost-effective and sustainable infrastructure CSIL CERN CSIL CERN CSIL CERN SN USC + WIFO LSE CINT CERN CNRS CEREMA CETU, CSIL WP4 deliverables 3 Space for additional logos 05 December 2022/ FCCIS Workshop Emanuela Sirtori (CSIL) Methodology and main assumptions Methodology: StR-ESFRI "Guidelines on cost estimation of research infrastructures" (2019) and the European Commission's "Guide to Cost-Benefit Analysis of Investment Projects (2014). Time profile: from 2021 (assumed year of start of feasibility studies) until 2057 (assumed last year of exploitation of the FCC-ee results) – total of 37 years Unit of measure: CHF, in real terms at 2021 prices. Who bears the costs: CERN and all other institutes Residual value: At the end of its lifetime, the FCC-ee infrastructure could be partly re-used for subsequent projects. Therefore, no costs of FCC-ee dismantling and infrastructure adaptation at the end of its lifetime have been included in the cost estimates. A residual value is instead estimated. Investment costs: Pre-investments Accelerator systems Infrastructure systems Civil engineering works Operating costs: Labour costs (67% of total) Maintenance and repair Utilities and services (e.g. electricity, water) Consumables (e.g. cryogenics) Management and administration Others Cost estimates 4 Space for additional logos Cost structure Timeline 05 December 2022/ FCCIS Workshop Emanuela Sirtori (CSIL) Cost estimates (cont’d) 5 Space for additional logos Timeline 05 December 2022/ FCCIS Workshop Emanuela Sirtori (CSIL) People engaged in the project Quantification of the human resources needed during the project life-time (both on the FCC-ee accelerator and infrastructure and on the experiments) Main assumption: 2 large(CMS/ATLAS like) experiment collaborations No distinction between CERN and other employees 6 Socio-economic impact analysis Long-time perspective, covering the entire life time of the FCC-ee Mix of methods: resulting KPI structured according to the RIPATHS framework Where possible, benefits are translated into monetary terms Quantification of the minimum likeley expected socio-economic return Probabilistic model, building on historical data and expert opinion Distinction between: global and territorial impacts directly caused and
