Progress Report of the Working Committee on Capital Account Liberalisation (WC-CAL) 22nd Senior Level Committee 26 October 2021 Executive Summary AEC 2025 1 2 3 4 5 6 7 Priorities RMT SAP KPI Others (if any) Cap Building AEC 2026
"Progress Report of the Working Committee on" is the property of its rightful owner. Permission is granted to
download and print the materials on this website for personal, non-commercial use only, and to display it
on your personal computer provided you do not modify the materials and that you retain all copyright
notices contained in the materials. By downloading content from our website, you accept the terms of this
agreement.
Presentation Transcript
01
Progress Report of the Working Committee on Capital Account Liberalisation (WC-CAL) 22nd Senior Level Committee 26 October 2021<br>
02

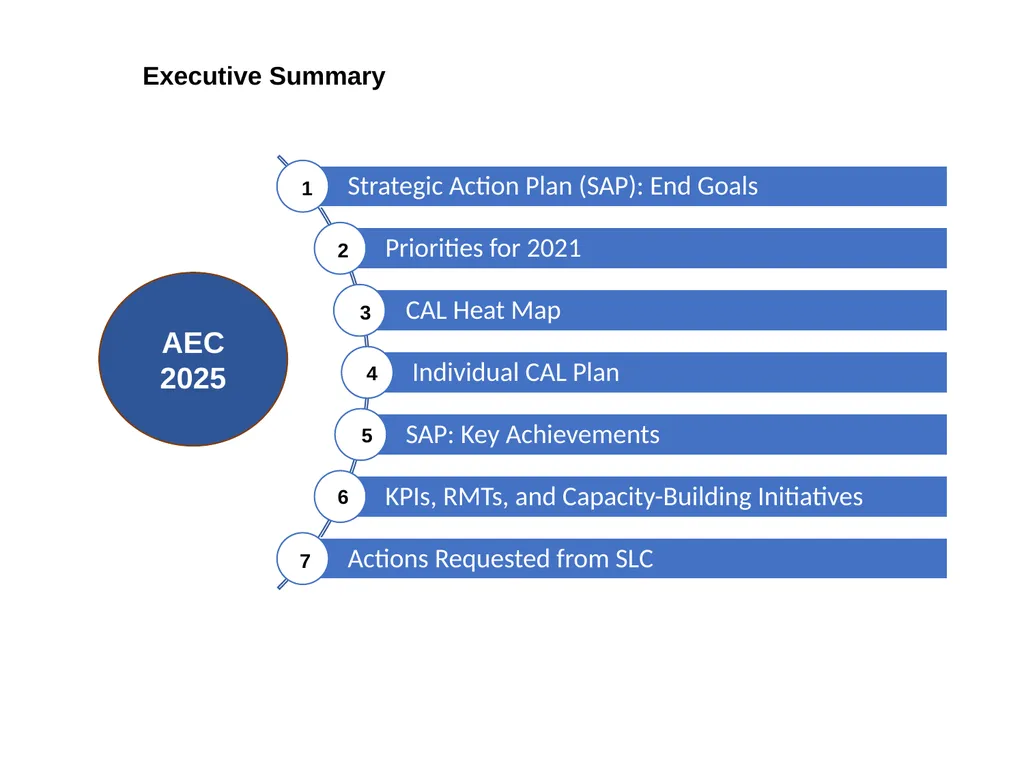

Executive Summary AEC 2025 1 2 3 4 5 6 7<br>
03
Priorities RMT SAP KPI Others
(if any) Cap
Building AEC

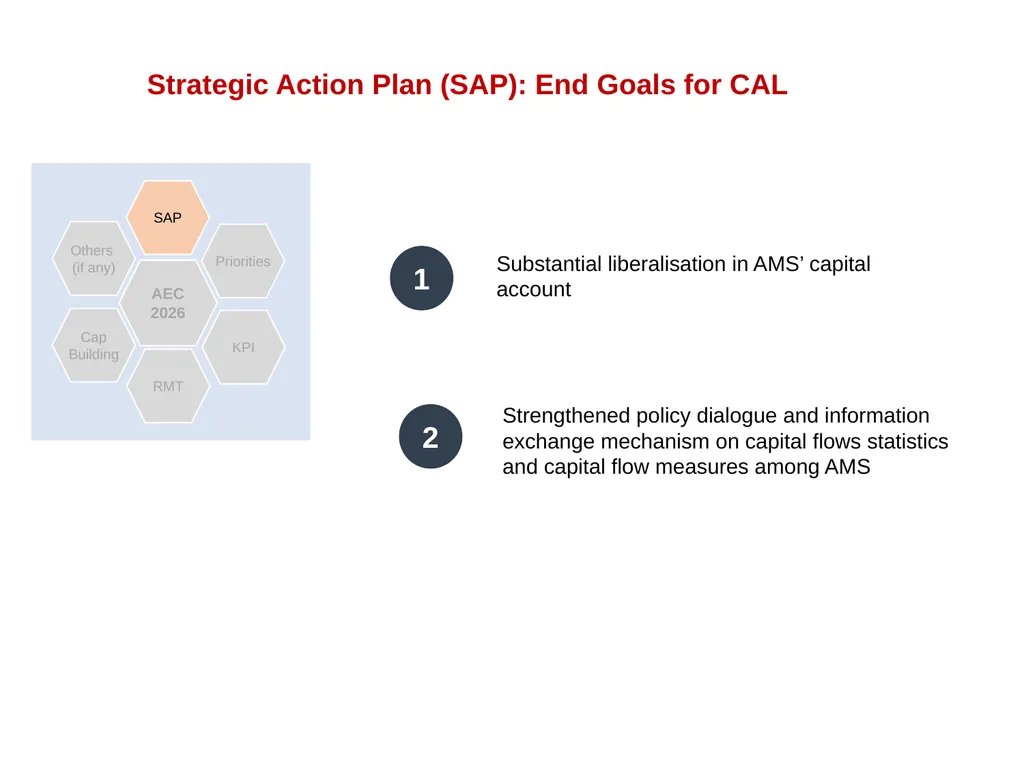

2026 Substantial liberalisation in AMS’ capital account 1 2 Strengthened policy dialogue and information exchange mechanism on capital flows statistics and capital flow measures among AMS Strategic Action Plan (SAP): End Goals for CAL<br>
04

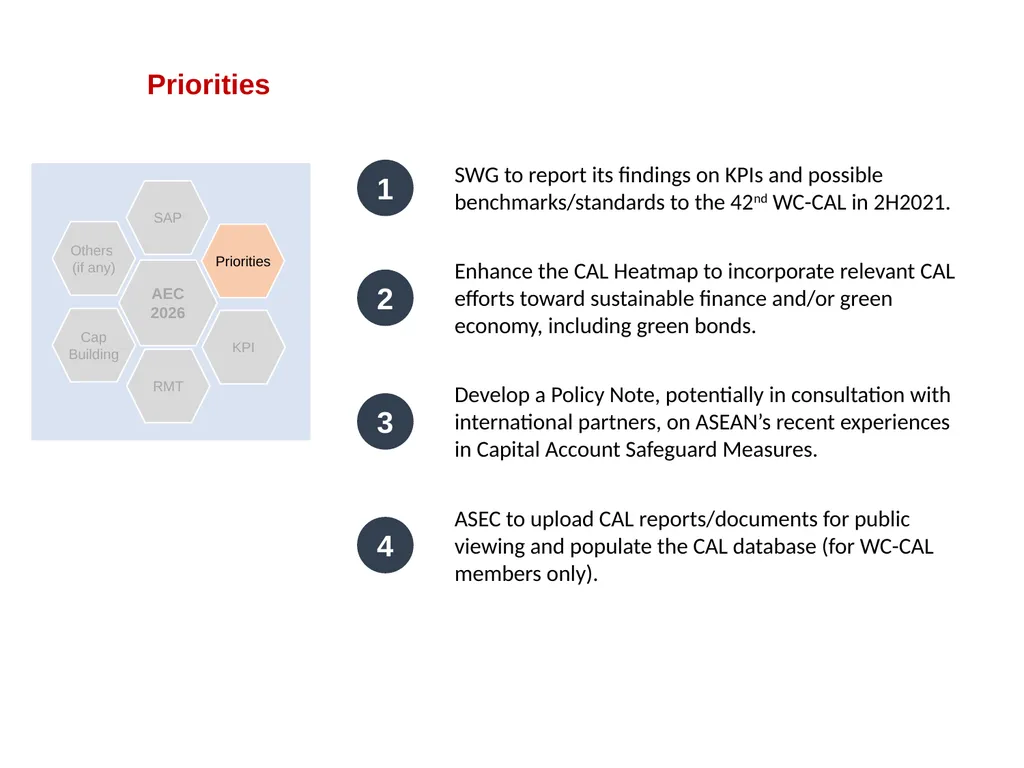

Priorities Priorities RMT SAP KPI Others
(if any) Cap
Building AEC
2026 SWG to report its findings on KPIs and possible benchmarks/standards to the 42nd WC-CAL in 2H2021. 1 2 3 Enhance the CAL Heatmap to incorporate relevant CAL efforts toward sustainable finance and/or green economy, including green bonds. Develop a Policy Note, potentially in consultation with international partners, on ASEAN’s recent experiences in Capital Account Safeguard Measures. 4 ASEC to upload CAL reports/documents for public viewing and populate the CAL database (for WC-CAL members only).<br>
05

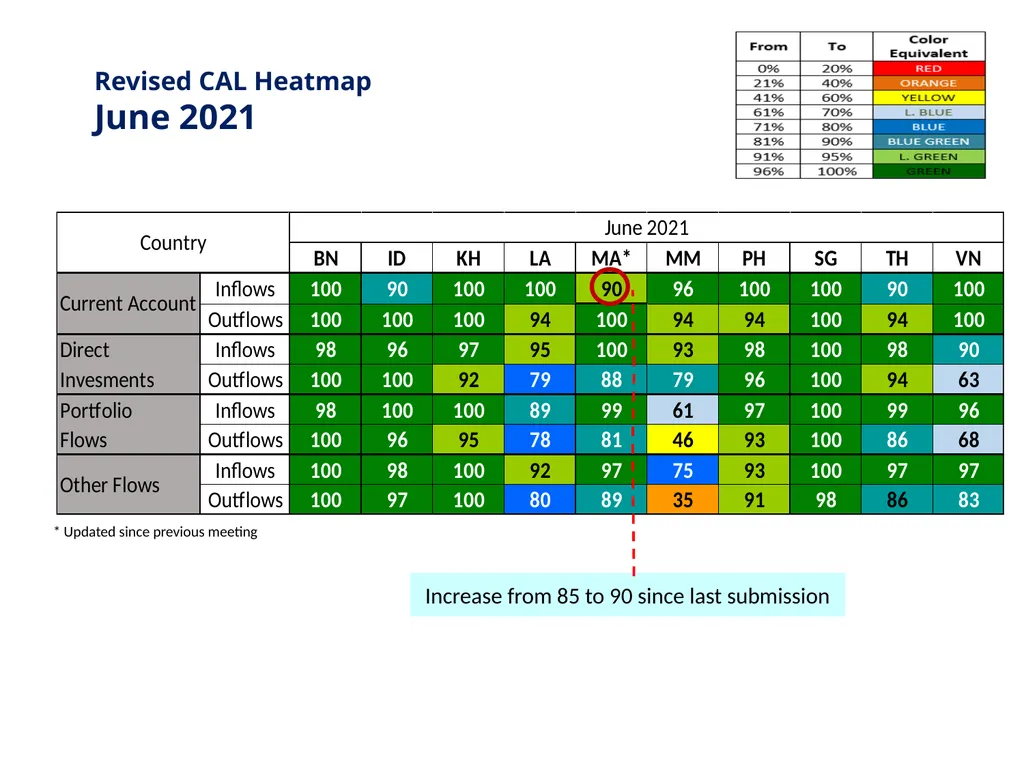

Revised CAL Heatmap
June 2021 * Updated since previous meeting Increase from 85 to 90 since last submission<br>
06
SG – no submission, fully liberalized

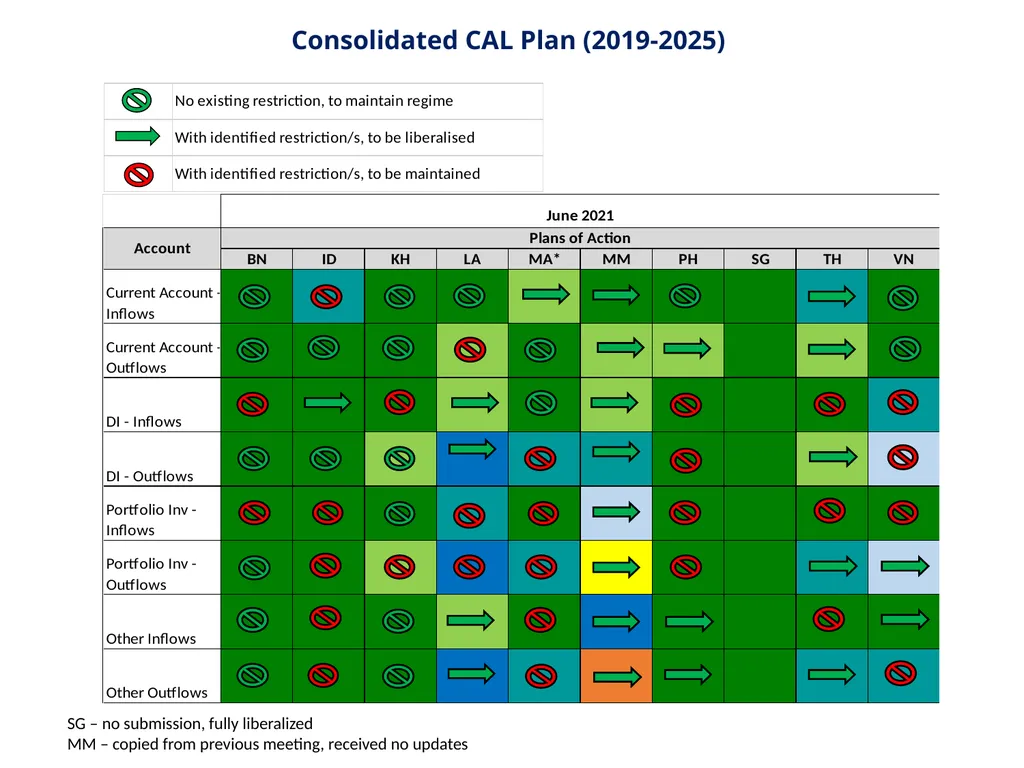

MM – copied from previous meeting, received no updates Consolidated CAL Plan (2019-2025)<br>
07

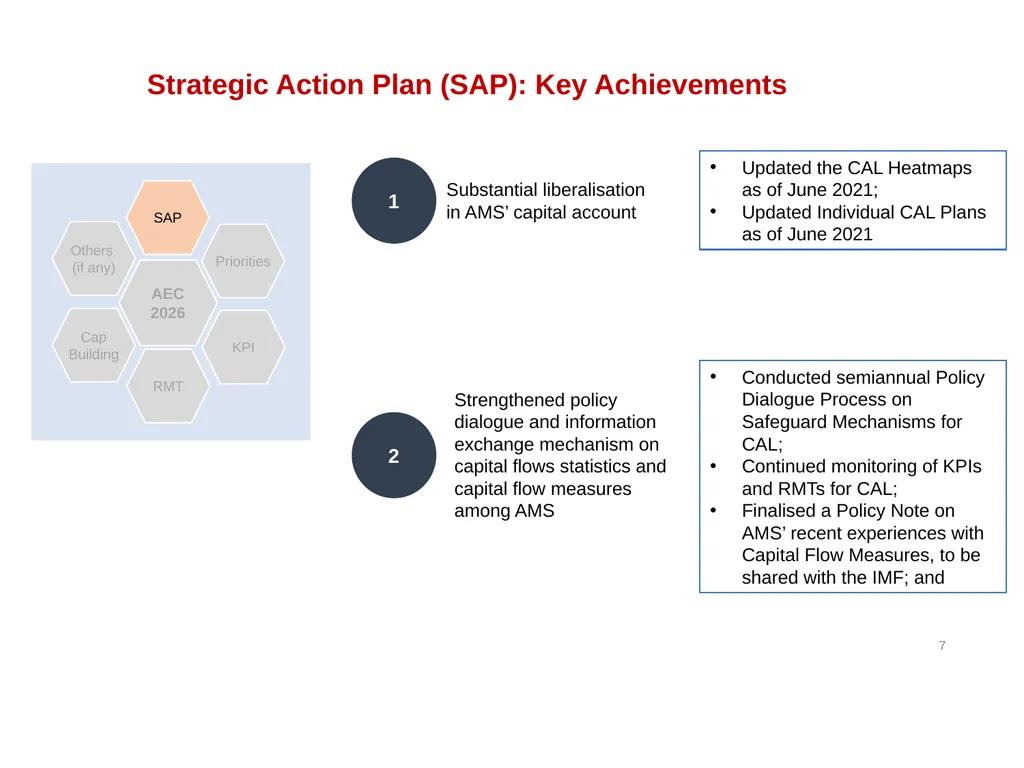

Strategic Action Plan (SAP): Key Achievements Priorities RMT SAP KPI Others
(if any) Cap
Building AEC
2026 7 Substantial liberalisation in AMS’ capital account 1 2 Strengthened policy dialogue and information exchange mechanism on capital flows statistics and capital flow measures among AMS Conducted semiannual Policy Dialogue Process on Safeguard Mechanisms for CAL;
Continued monitoring of KPIs and RMTs for CAL;
Finalised a Policy Note on AMS’ recent experiences with Capital Flow Measures, to be shared with the IMF; and Updated the CAL Heatmaps as of June 2021;
Updated Individual CAL Plans as of June 2021<br>
08
Priorities RMT SAP KPI Others
(if any) Cap
Building AEC

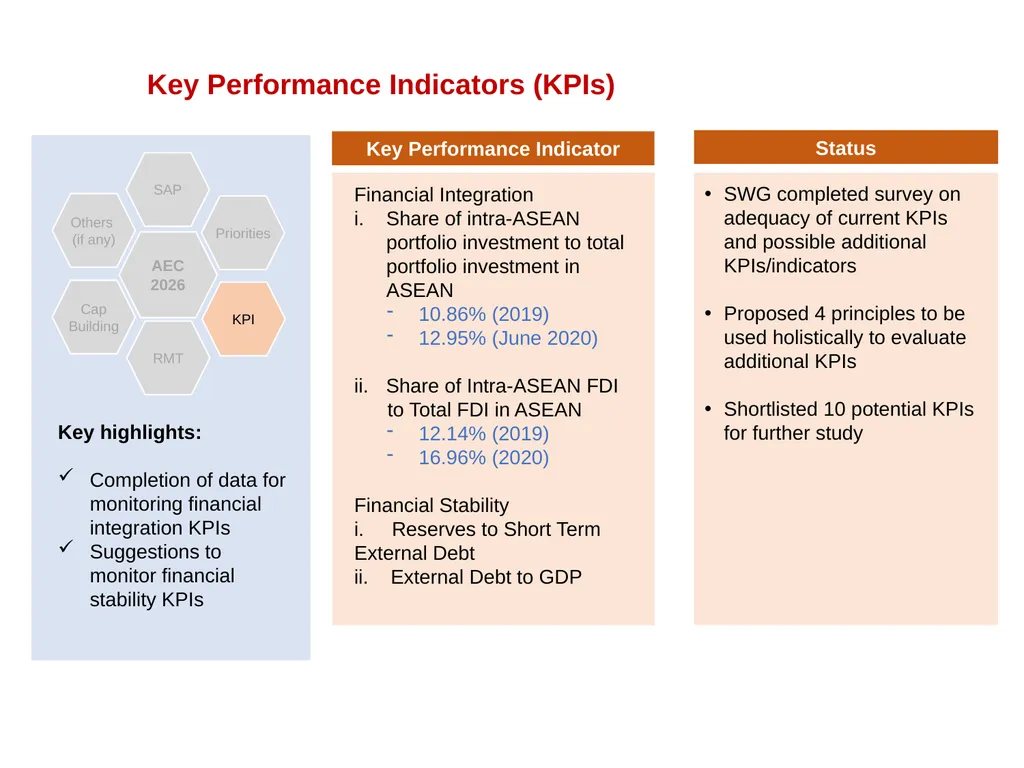

2026 Key Performance Indicators (KPIs) Key Performance Indicator Status Financial Integration
Share of intra-ASEAN portfolio investment to total portfolio investment in ASEAN
10.86% (2019)
12.95% (June 2020)
Share of Intra-ASEAN FDI
to Total FDI in ASEAN
12.14% (2019)
16.96% (2020)
Financial Stability i. Reserves to Short Term External Debt
ii. External Debt to GDP SWG completed survey on adequacy of current KPIs and possible additional KPIs/indicators
Proposed 4 principles to be used holistically to evaluate additional KPIs
Shortlisted 10 potential KPIs for further study Key highlights:
Completion of data for monitoring financial integration KPIs
Suggestions to monitor financial stability KPIs<br>
09

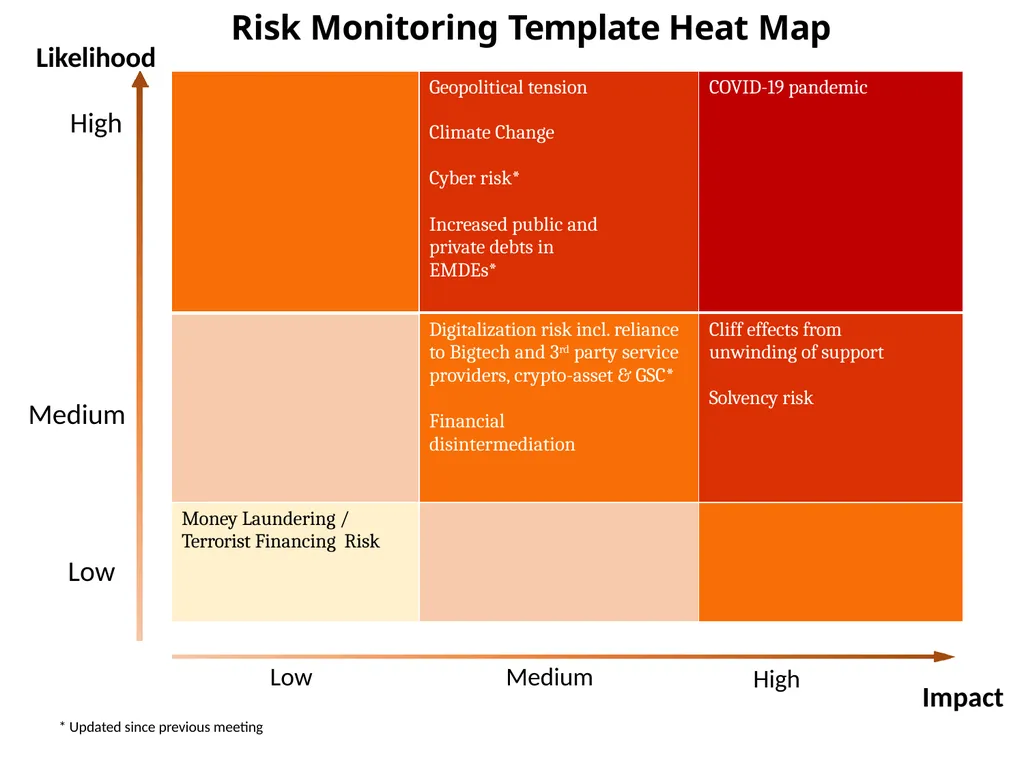

Impact Low Medium High Medium Likelihood
High Low Risk Monitoring Template Heat Map * Updated since previous meeting<br>
10
Priorities RMT SAP KPI Others
(if any) Cap
Building AEC

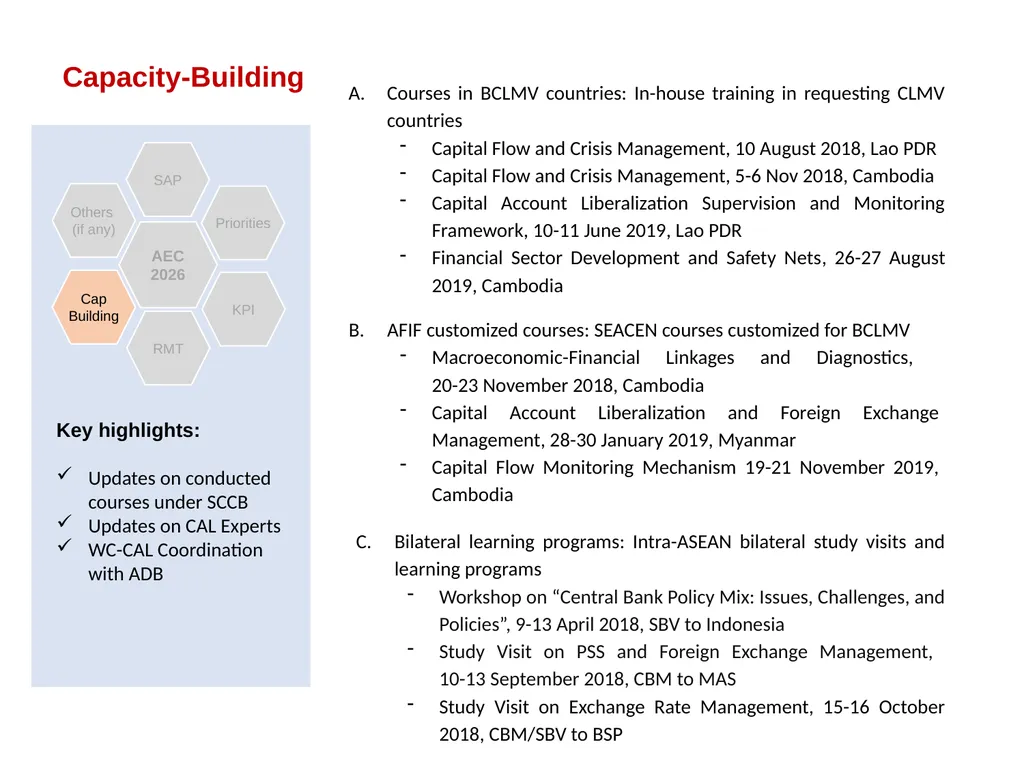

2026 Capacity-Building Courses in BCLMV countries: In-house training in requesting CLMV countries
Capital Flow and Crisis Management, 10 August 2018, Lao PDR
Capital Flow and Crisis Management, 5-6 Nov 2018, Cambodia
Capital Account Liberalization Supervision and Monitoring Framework, 10-11 June 2019, Lao PDR
Financial Sector Development and Safety Nets, 26-27 August 2019, Cambodia AFIF customized courses: SEACEN courses customized for BCLMV
Macroeconomic-Financial Linkages and Diagnostics, 20-23 November 2018, Cambodia
Capital Account Liberalization and Foreign Exchange Management, 28-30 January 2019, Myanmar
Capital Flow Monitoring Mechanism 19-21 November 2019, Cambodia Bilateral learning programs: Intra-ASEAN bilateral study visits and learning programs
Workshop on “Central Bank Policy Mix: Issues, Challenges, and Policies”, 9-13 April 2018, SBV to Indonesia
Study Visit on PSS and Foreign Exchange Management, 10-13 September 2018, CBM to MAS
Study Visit on Exchange Rate Management, 15-16 October 2018, CBM/SBV to BSP Key highlights:
Updates on conducted courses under SCCB
Updates on CAL Experts
WC-CAL Coordination with ADB<br>
11

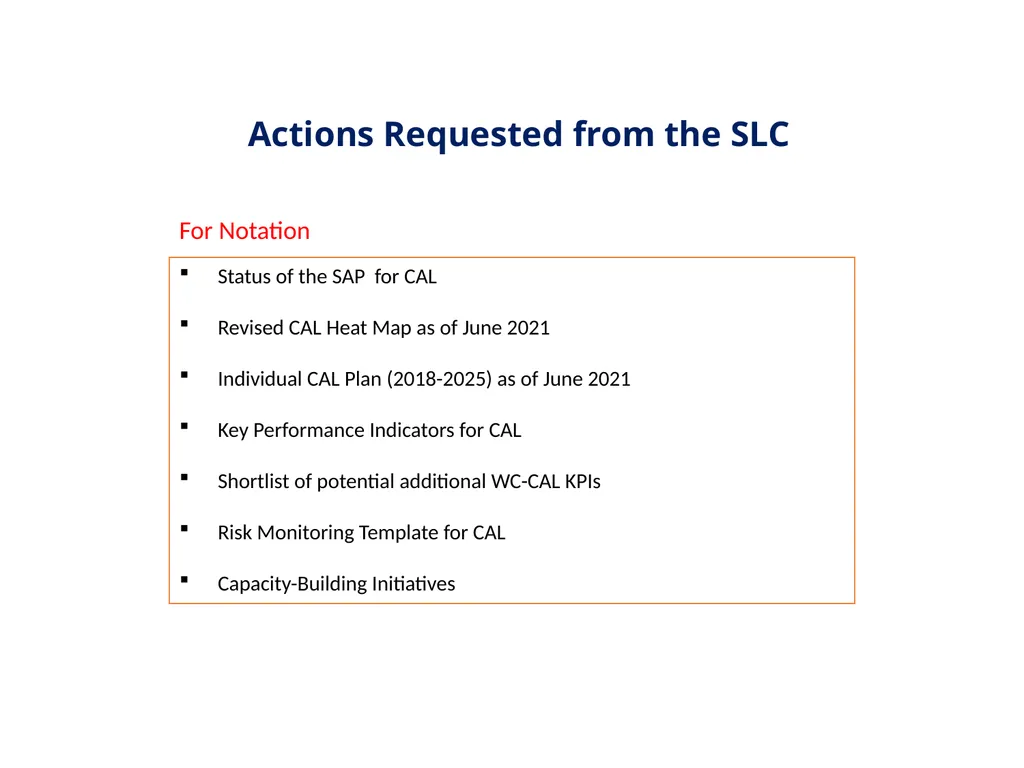

Actions Requested from the SLC Status of the SAP for CAL
