Resource Plan and Project Budget LOOM.02.124 - slide 1 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 2 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 3 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 4 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 5 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 6 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 7 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 8 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 9 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 10 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 11 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 12 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 13 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 14 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 15 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 16 of 17 Resource Plan and Project Budget LOOM.02.124 - slide 17 of 17
Description: Resource Plan and Project Budget LOOM.02.124 Project Management By Dr. Kairi Põldsaar Resource Plan Types of Resources Services outsourcing, sub-contractors Labor staff involved in the project Equipment things needed during the

Related Topics

Download Presentation

"Resource Plan and Project Budget LOOM.02.124" is the property of its rightful owner. Permission is granted to download and print the materials on this website for personal, non-commercial use only, and to display it on your personal computer provided you do not modify the materials and that you retain all copyright notices contained in the materials. By downloading content from our website, you accept the terms of this agreement.

Presentation Transcript

slide1. Resource Plan and Project Budget LOOM.02.124 Project Management
By Dr. Kairi Põldsaar<br>

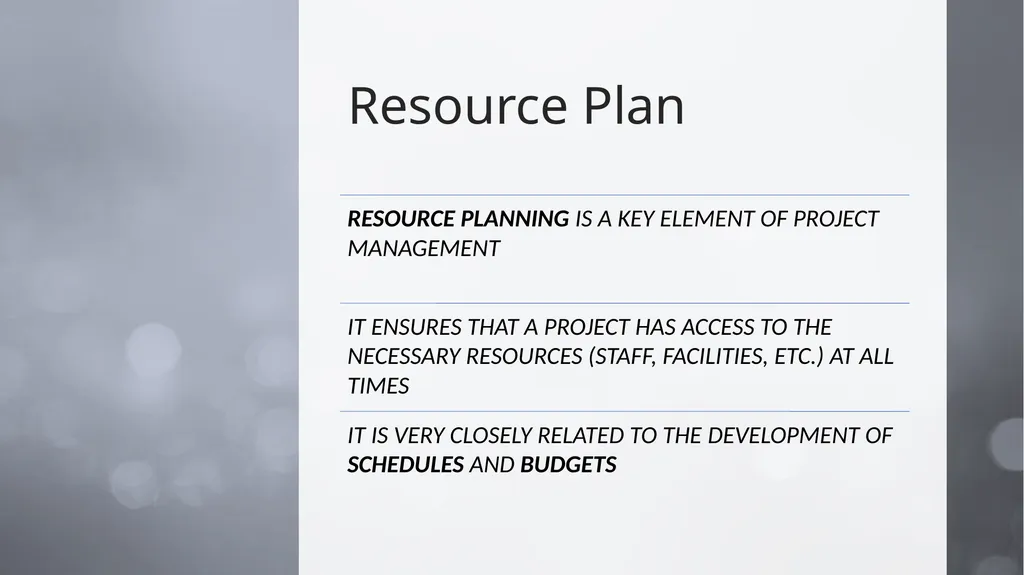

slide2. Resource Plan<br>

slide3. Types of Resources Services – outsourcing, sub-contractors
Labor – staff involved in the project
Equipment – things needed during the project, and can be used later for other projects
Materials – things needed for the project, can be part of deliverables/outcome
Money – needed to aquire and maintain all the other resources
Space – office, factory, etc.
Time – amount of all the other resources needed depends on time variable<br>

slide4. Resource Plan A resource plan aims to use resources in
the most efficient manner possible,
thus contributing to the overall productivity of the project<br>

slide5. Important questions to ask while compiling resources plan: What are the roles of the project team?
What are the procurement needs of the project?
What types of contracts are required?
Are there any pre-qualification methods needed?
What criteria will be used to select contractors or vendors?
How much of the budget is allocated to resources?
How will performance be measured in the project?
What policies and procedures will be used?<br>

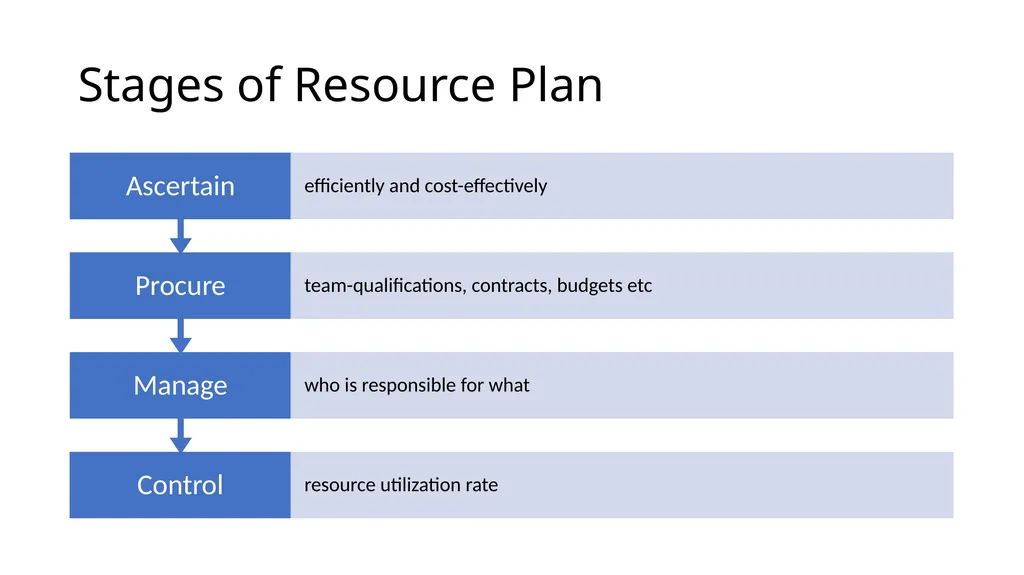

slide6. Stages of Resource Plan<br>

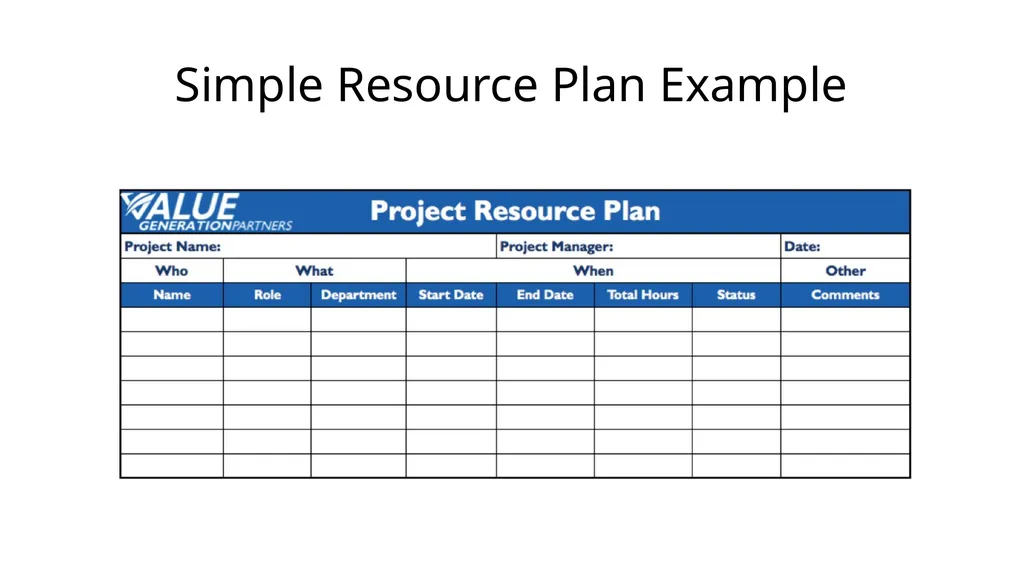

slide7. Simple Resource Plan Example<br>

slide8. What Is a Budget?<br>

slide9. Surplus budget – profits are anticipated

Balanced budget – revenues equal expenditures

Deficit budget – expenses will exceed revenues<br>

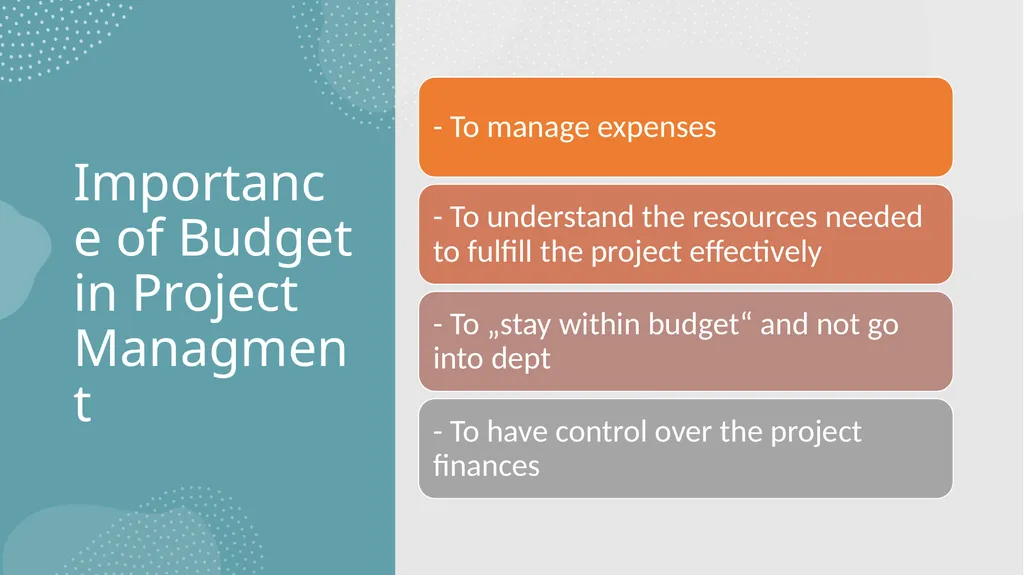

slide10. Importance of Budget in Project Managment<br>

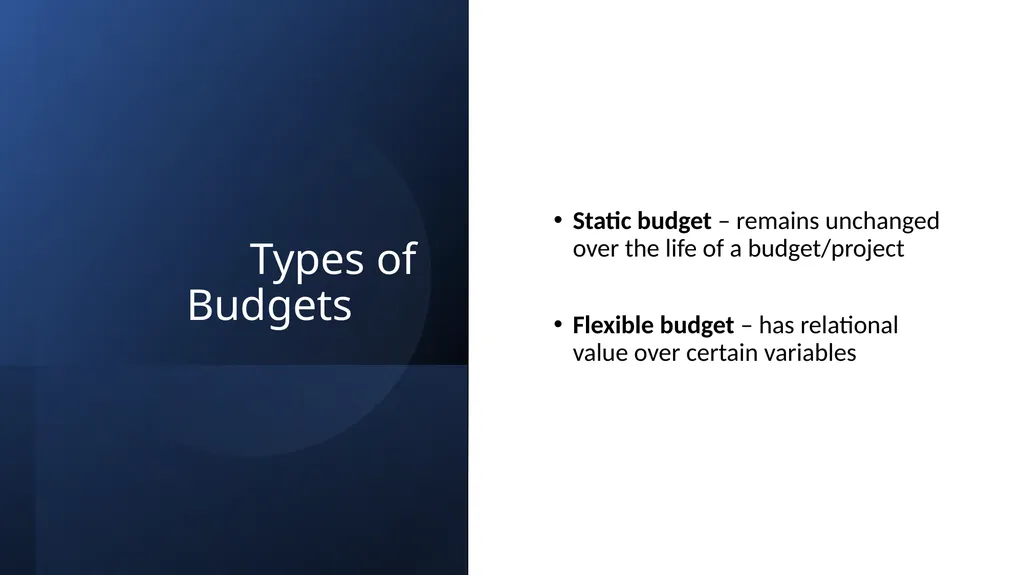

slide11. Types of Budgets Static budget – remains unchanged over the life of a budget/project

Flexible budget – has relational value over certain variables<br>

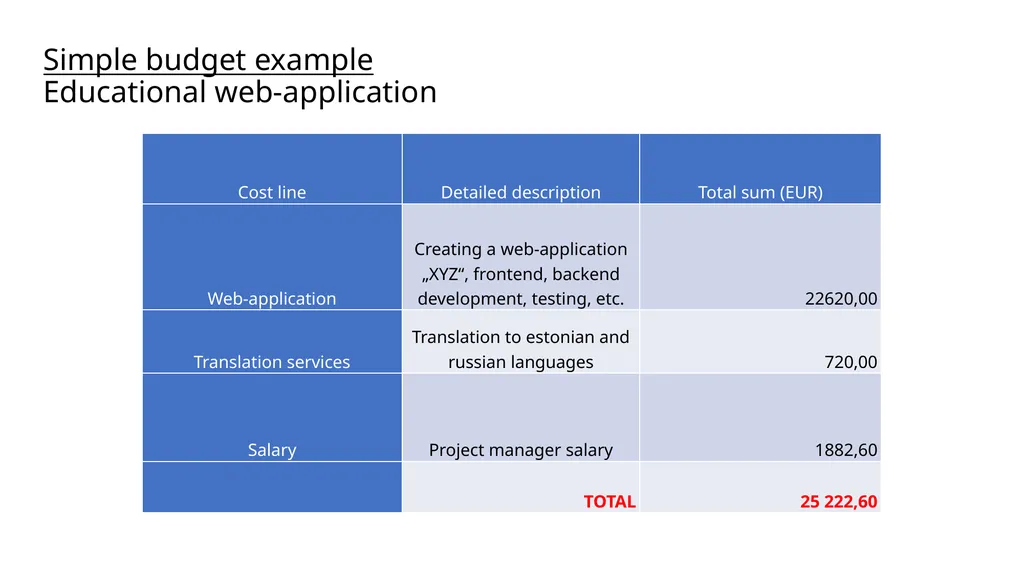

slide12. Simple budget example
Educational web-application<br>

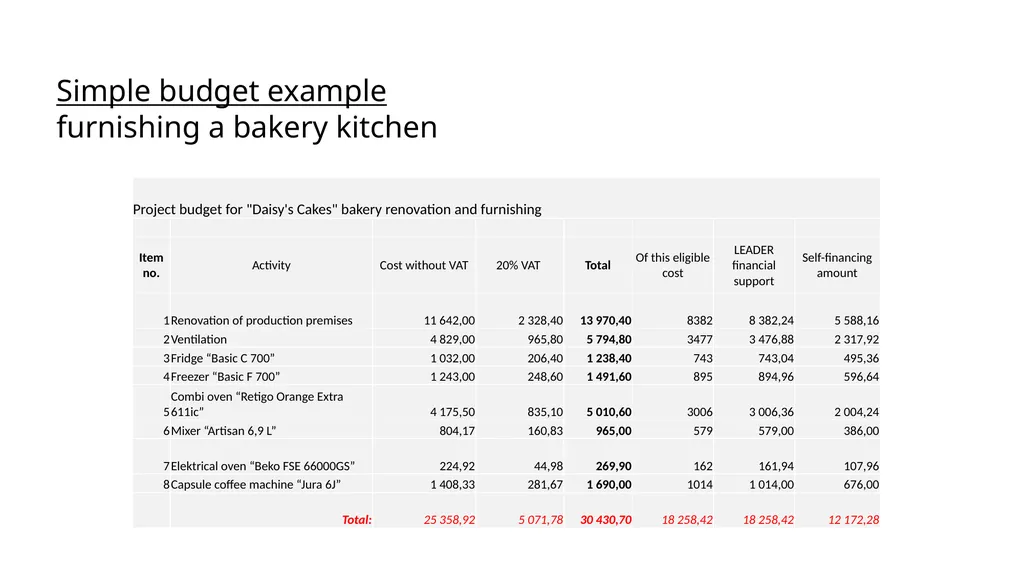

slide13. Simple budget example furnishing a bakery kitchen<br>

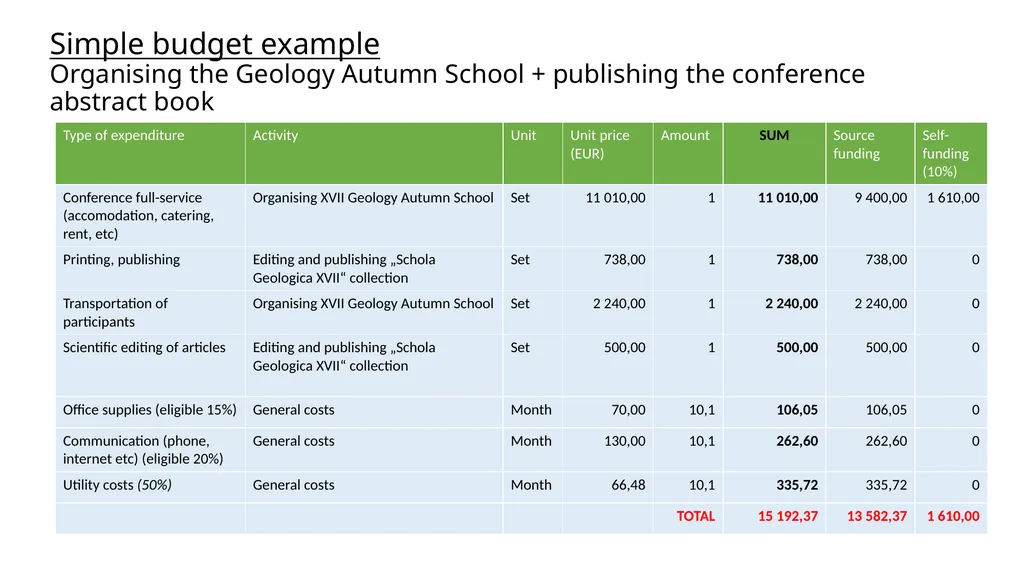

slide14. Simple budget example Organising the Geology Autumn School + publishing the conference abstract book<br>

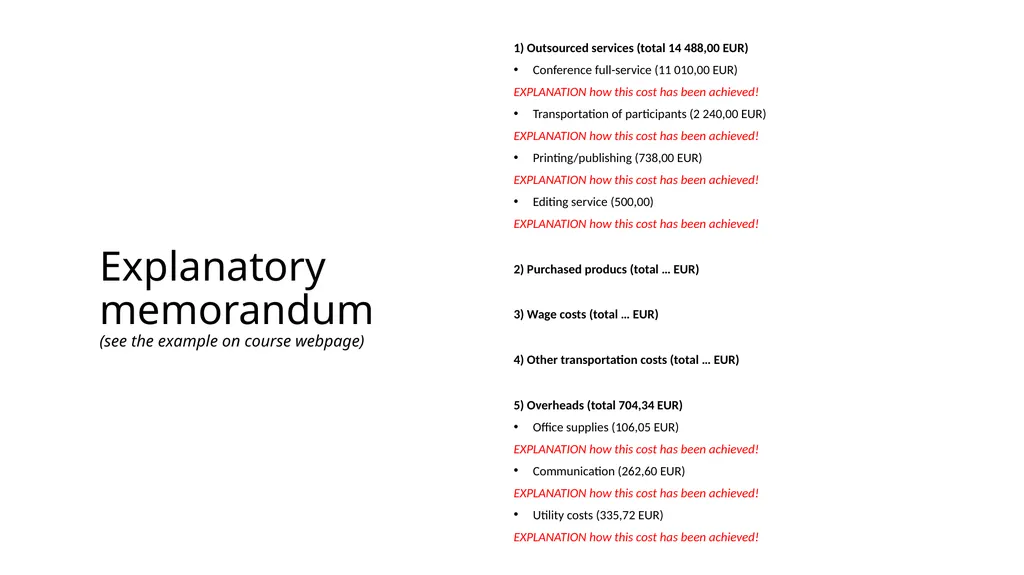

slide15. Explanatory memorandum (see the example on course webpage) 1) Outsourced services (total 14 488,00 EUR)
Conference full-service (11 010,00 EUR)
EXPLANATION how this cost has been achieved!
Transportation of participants (2 240,00 EUR)
EXPLANATION how this cost has been achieved!
Printing/publishing (738,00 EUR)
EXPLANATION how this cost has been achieved!
Editing service (500,00)
EXPLANATION how this cost has been achieved!

2) Purchased producs (total … EUR)

3) Wage costs (total … EUR)

4) Other transportation costs (total … EUR)

5) Overheads (total 704,34 EUR)
Office supplies (106,05 EUR)
EXPLANATION how this cost has been achieved!
Communication (262,60 EUR)
EXPLANATION how this cost has been achieved!
Utility costs (335,72 EUR)
EXPLANATION how this cost has been achieved!<br>

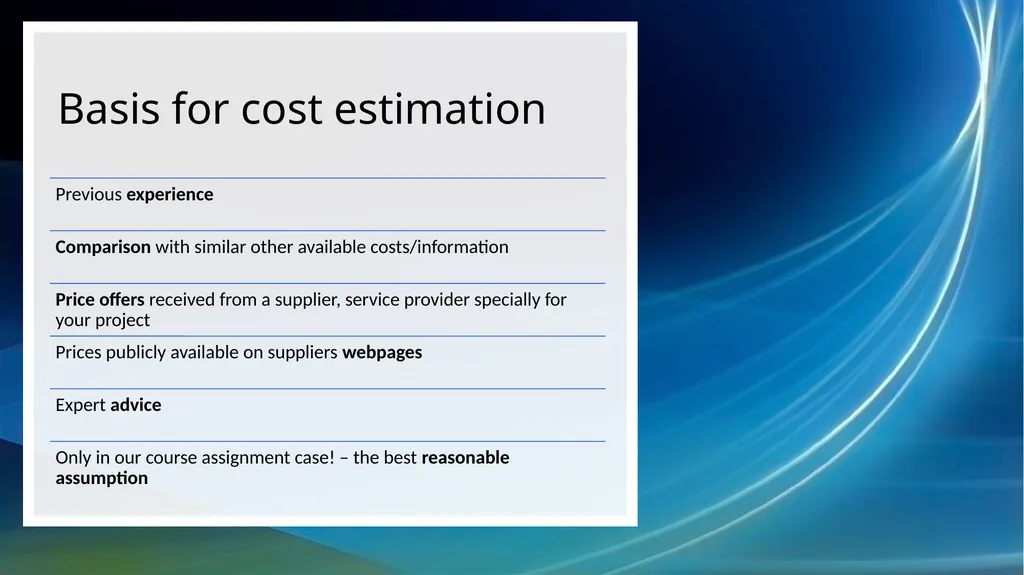

slide16. Basis for cost estimation<br>

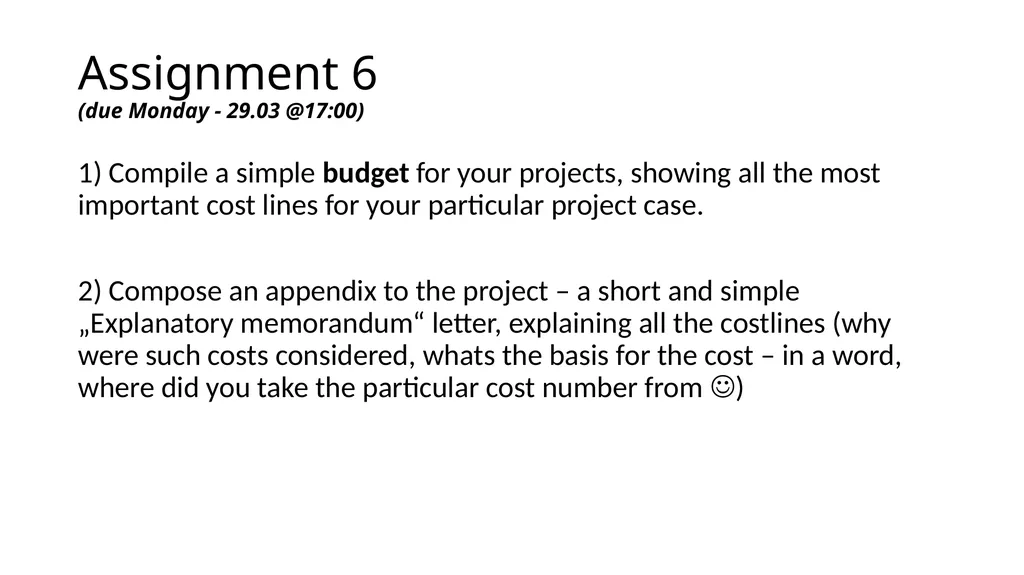

slide17. Assignment 6 (due Monday - 29.03 @17:00) 1) Compile a simple budget for your projects, showing all the most important cost lines for your particular project case.

2) Compose an appendix to the project – a short and simple „Explanatory memorandum“ letter, explaining all the costlines (why were such costs considered, whats the basis for the cost – in a word, where did you take the particular cost number from )<br>
