NCRMP Phase-I, Project Steering Committee Meeting

Published  . 0 views
↓ Download
NCRMP Phase-I, Project Steering Committee Meeting
1 / 1
NCRMP Phase-I, Project Steering Committee Meeting - slide 1 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 2 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 3 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 4 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 5 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 6 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 7 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 8 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 9 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 10 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 11 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 12 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 13 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 14 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 15 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 16 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 17 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 18 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 19 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 20 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 21 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 22 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 23 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 24 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 25 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 26 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 27 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 28 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 29 of 30 NCRMP Phase-I, Project Steering Committee Meeting - slide 30 of 30
Description: NCRMP Phase-I, Project Steering Committee Meeting Quarter ending March, 2017 1 National Cyclone Risk Mitigation Project Objective- to reduce the cyclone risk and vulnerability in the coastal areas, develop an effective Early Warning

Related Topics

Download Presentation

"NCRMP Phase-I, Project Steering Committee Meeting" is the property of its rightful owner. Permission is granted to download and print the materials on this website for personal, non-commercial use only, and to display it on your personal computer provided you do not modify the materials and that you retain all copyright notices contained in the materials. By downloading content from our website, you accept the terms of this agreement.

Presentation Transcript

slide1. NCRMP Phase-I,
Project Steering Committee Meeting
Quarter ending March, 2017 1<br>

slide2. National Cyclone Risk Mitigation Project Objective- to reduce the cyclone risk and vulnerability in the coastal areas, develop an effective Early Warning Dissemination System to ensure last mile connectivity, erect Cyclone Risk Mitigation Infrastructure , build capacity of the coastal communities for risk mitigation.
Four Components- Comp.-A (EWDS); Comp.-B (Cyclone Risk Mitigation Infrastructure); Comp.- C ( Technical Assistance for Risk Mitigation & Capacity Building/Knowledge creation); Comp.-D (Project Management & Implementation Support).
Initial Outlay- Rs. 1496.71 Cr. ( World Bank share Rs. 1198.44 Cr. and State share Rs. 298.27 Cr. from AP and Odisha). Outlay enhanced by Rs. 835 Cr. for Additional Financing of Phase-I in July, 2015; revised outlay Rs. 2331.71 Cr.
Phase-I- commenced on 14.01.2011 for 5 years which is extended up to March, 2018 covering Andhra Pradesh and Odisha. 2<br>

slide3. Agenda Item No.1.Comp. A: Early Warning Dissemination System (EWDS) Multi-technology option (Satellite, Radio, Mass Messaging/ Mailing & Alert Sirens etc.) to provide reliable communication during disasters ensuring Last Mile Connectivity.
Status : 3 Contd….<br>

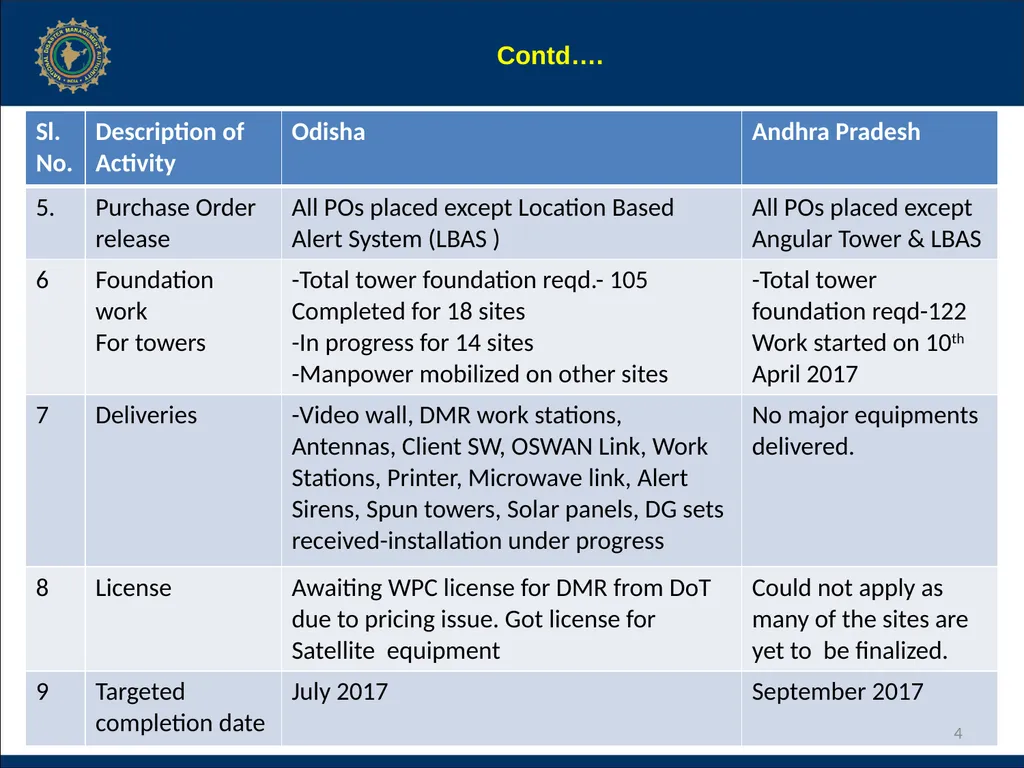

slide4. 4 Contd….<br>

slide5. Agenda Item No.2. Comp. B : Cyclone Risk Mitigation Infrastructure- Andhra Pradesh 5<br>

slide6. Agenda Item No.2 & 3. Comp-B : Schedule of completion of Remaining Works - Andhra Pradesh (Phase-I)<br>

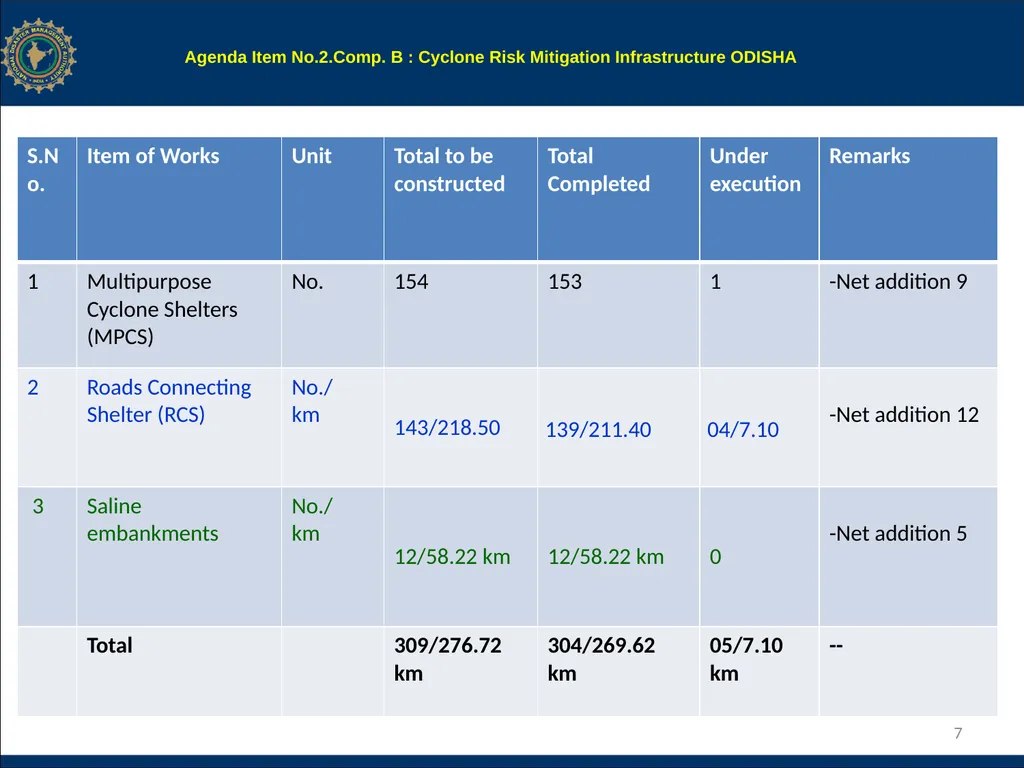

slide7. Agenda Item No.2.Comp. B : Cyclone Risk Mitigation Infrastructure ODISHA 7<br>

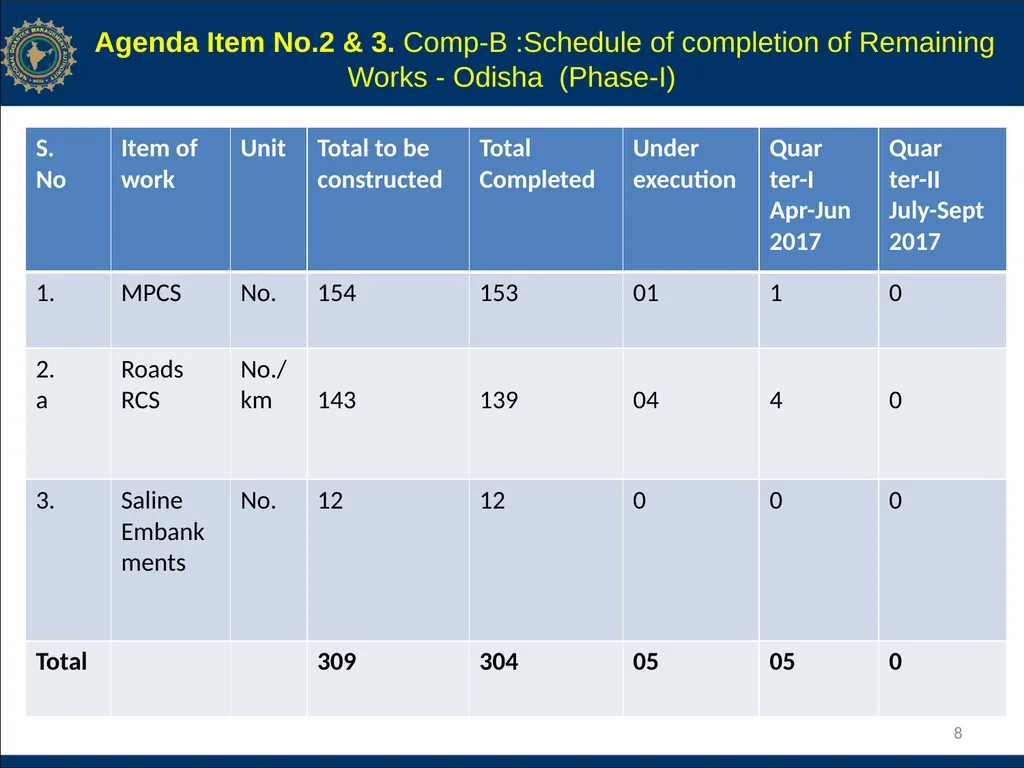

slide8. Agenda Item No.2 & 3. Comp-B :Schedule of completion of Remaining Works - Odisha (Phase-I) 8<br>

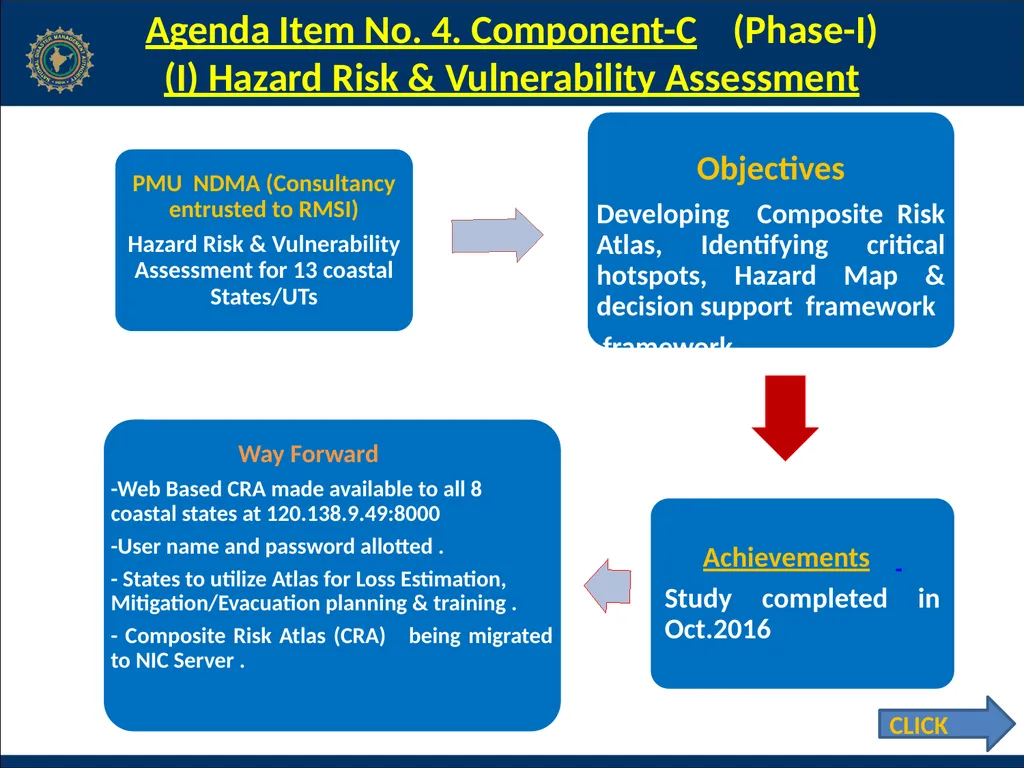

slide9. Agenda Item No. 4. Component-C (Phase-I) (I) Hazard Risk & Vulnerability Assessment CLICK<br>

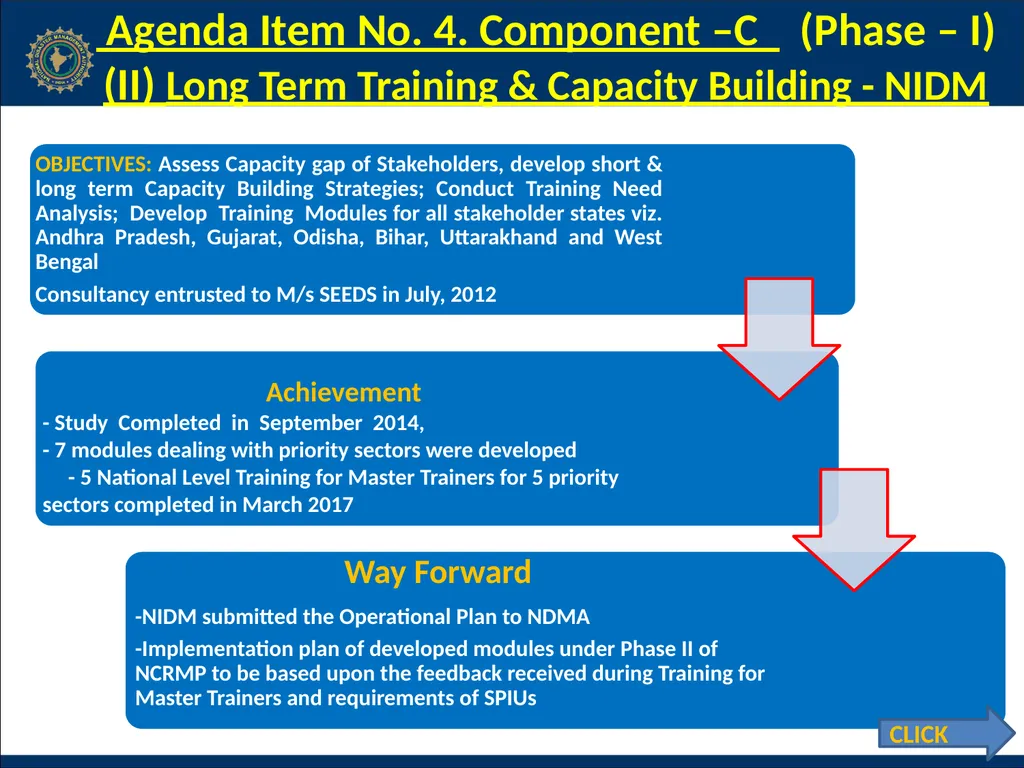

slide10. Agenda Item No. 4. Component –C (Phase – I) (II) Long Term Training & Capacity Building - NIDM 10 CLICK<br>

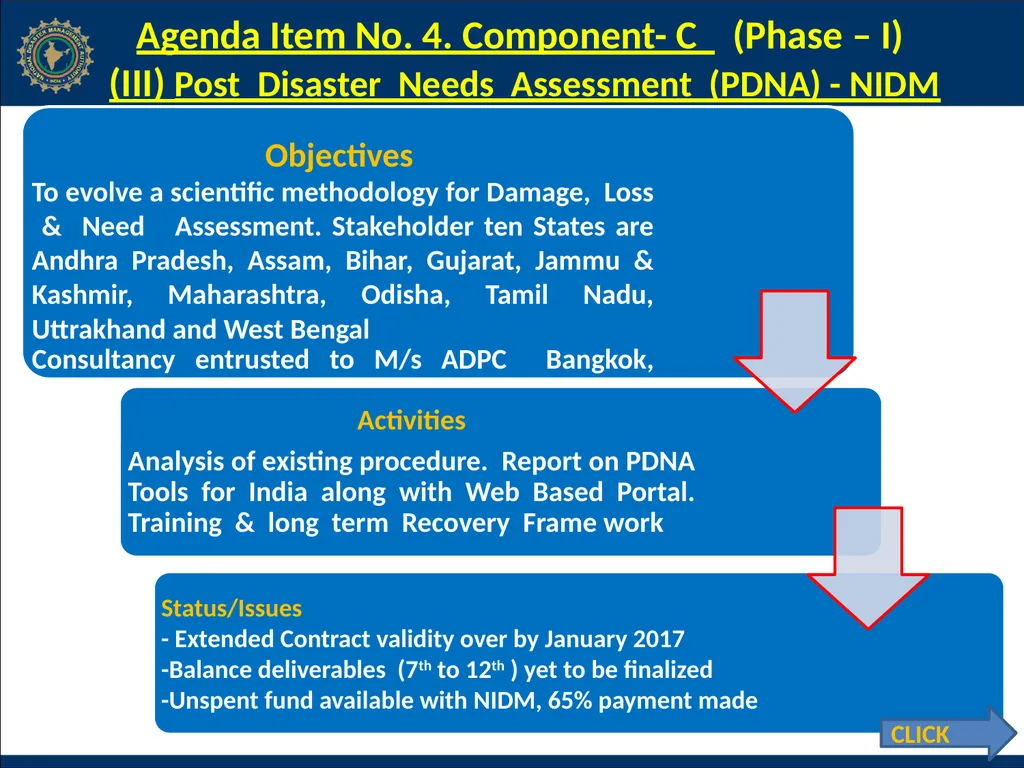

slide11. Agenda Item No. 4. Component- C (Phase – I) (III) Post Disaster Needs Assessment (PDNA) - NIDM CLICK<br>

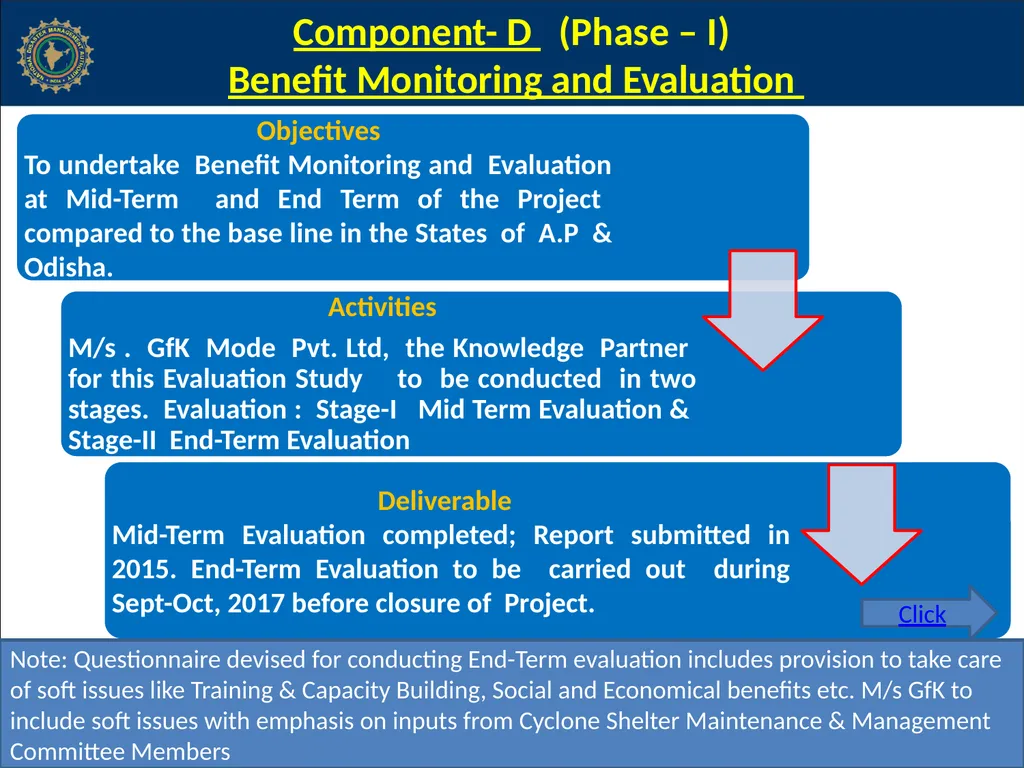

slide12. Component- D (Phase – I) Benefit Monitoring and Evaluation Click Note: Questionnaire devised for conducting End-Term evaluation includes provision to take care of soft issues like Training & Capacity Building, Social and Economical benefits etc. M/s GfK to include soft issues with emphasis on inputs from Cyclone Shelter Maintenance & Management Committee Members<br>

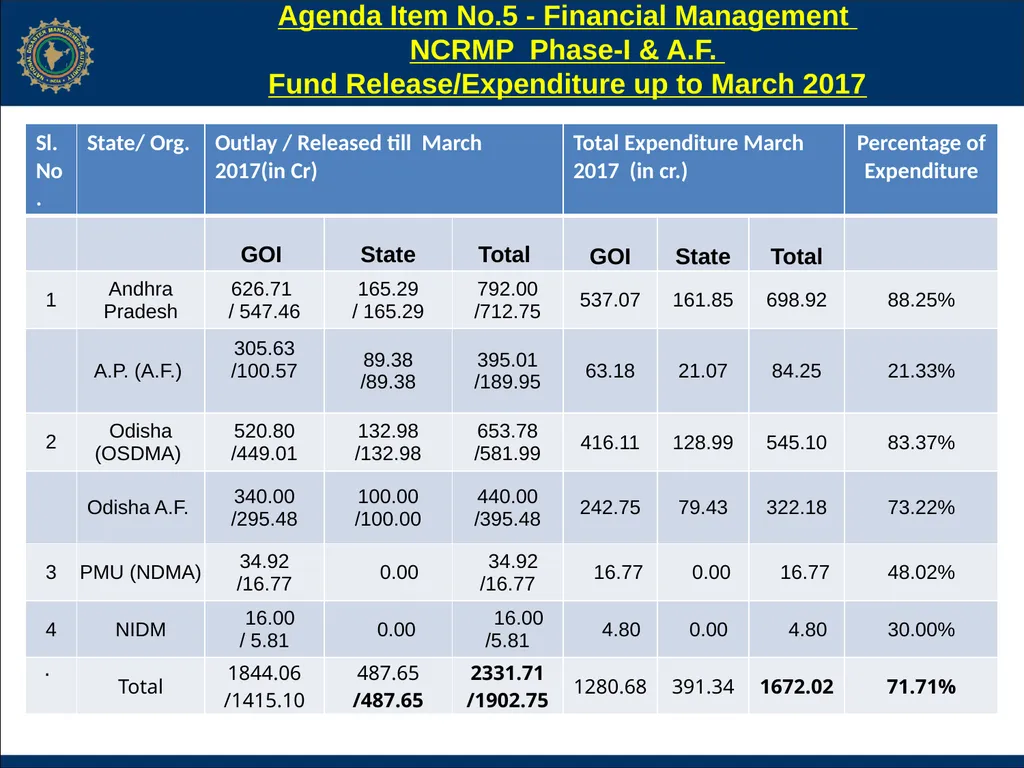

slide13. Agenda Item No.5 - Financial Management NCRMP Phase-I & A.F. Fund Release/Expenditure up to March 2017 .<br>

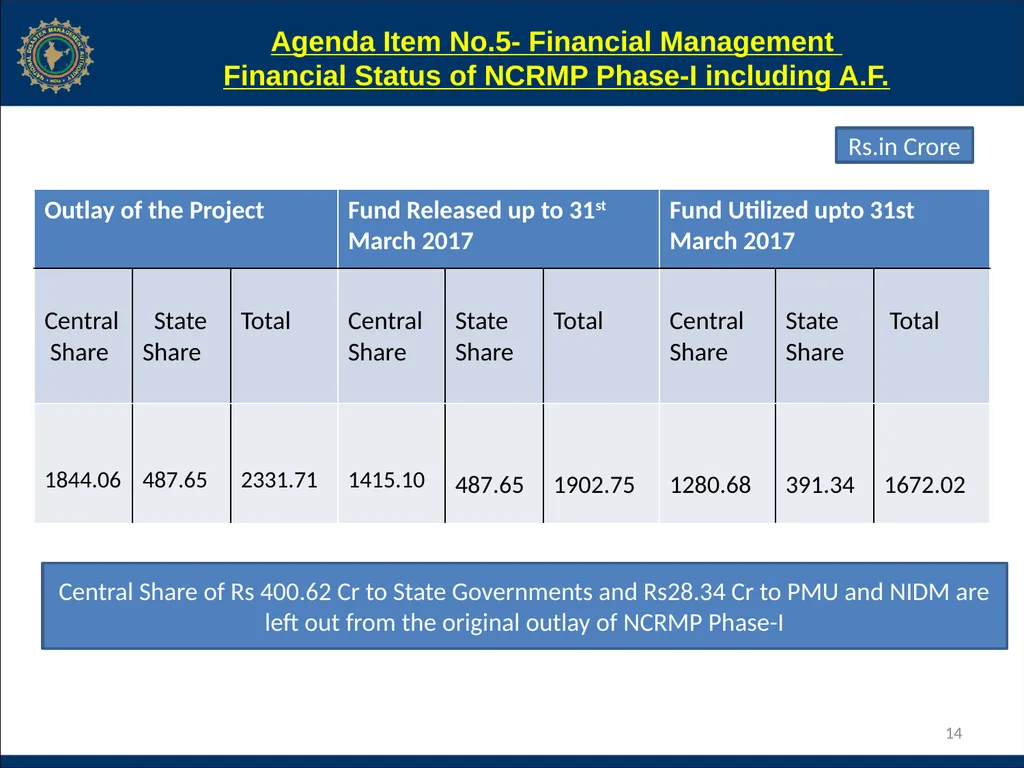

slide14. Agenda Item No.5- Financial Management Financial Status of NCRMP Phase-I including A.F. 14 Rs.in Crore Central Share of Rs 400.62 Cr to State Governments and Rs28.34 Cr to PMU and NIDM are left out from the original outlay of NCRMP Phase-I<br>

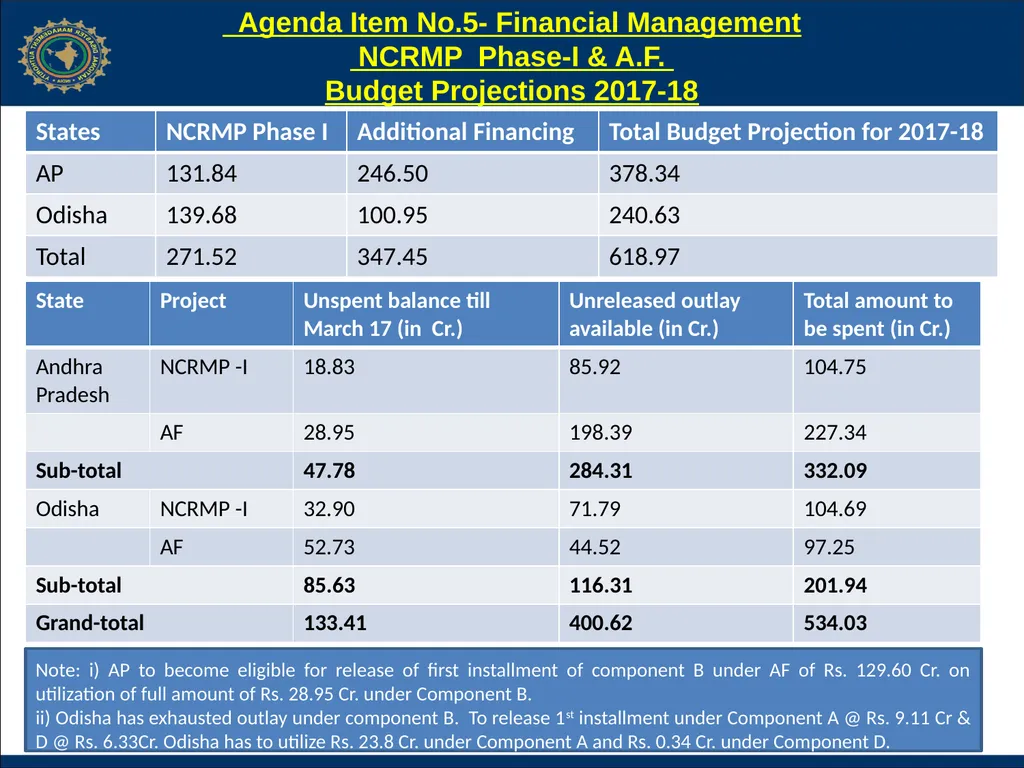

slide15. Agenda Item No.5- Financial Management NCRMP Phase-I & A.F. Budget Projections 2017-18 15 Note: i) AP to become eligible for release of first installment of component B under AF of Rs. 129.60 Cr. on utilization of full amount of Rs. 28.95 Cr. under Component B.
ii) Odisha has exhausted outlay under component B. To release 1st installment under Component A @ Rs. 9.11 Cr & D @ Rs. 6.33Cr. Odisha has to utilize Rs. 23.8 Cr. under Component A and Rs. 0.34 Cr. under Component D.<br>

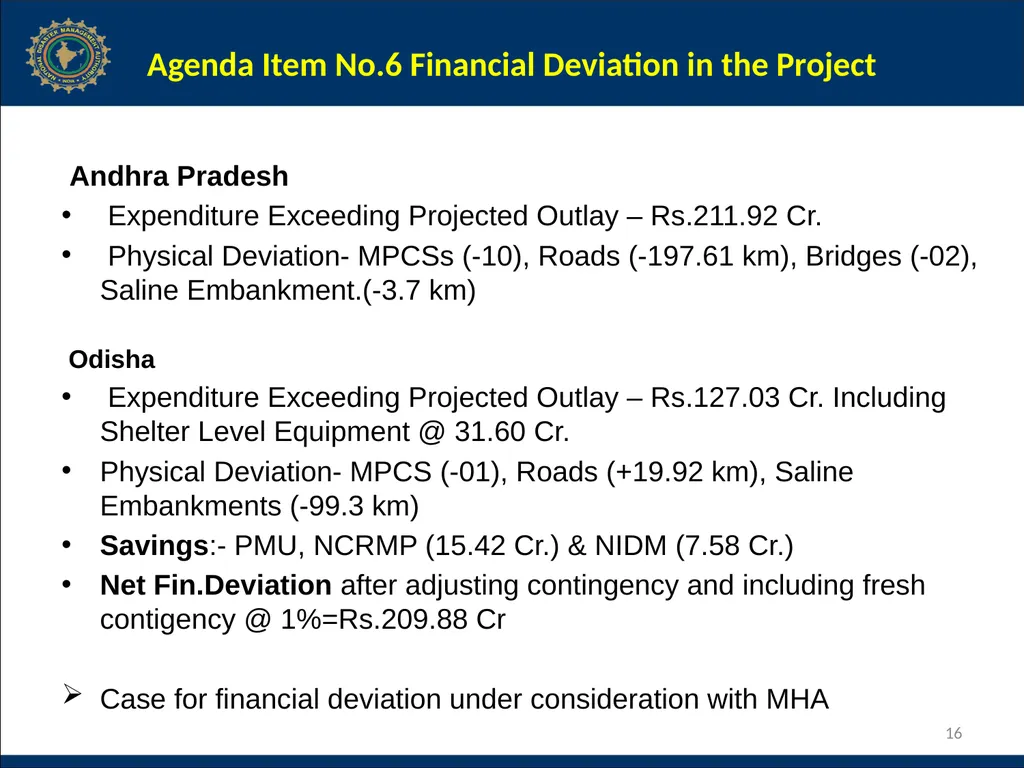

slide16. Agenda Item No.6 Financial Deviation in the Project Andhra Pradesh
Expenditure Exceeding Projected Outlay – Rs.211.92 Cr.
Physical Deviation- MPCSs (-10), Roads (-197.61 km), Bridges (-02), Saline Embankment.(-3.7 km)

Odisha
Expenditure Exceeding Projected Outlay – Rs.127.03 Cr. Including Shelter Level Equipment @ 31.60 Cr.
Physical Deviation- MPCS (-01), Roads (+19.92 km), Saline Embankments (-99.3 km)
Savings:- PMU, NCRMP (15.42 Cr.) & NIDM (7.58 Cr.)
Net Fin.Deviation after adjusting contingency and including fresh contigency @ 1%=Rs.209.88 Cr

Case for financial deviation under consideration with MHA 16<br>

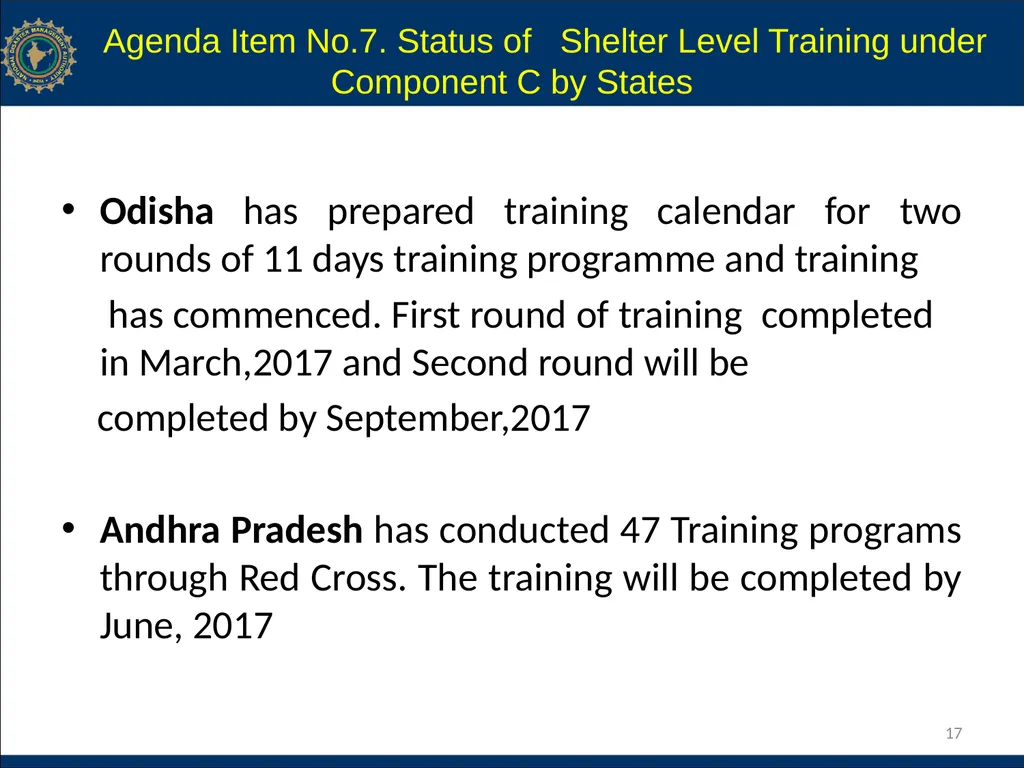

slide17. Agenda Item No.7. Status of Shelter Level Training under Component C by States Odisha has prepared training calendar for two rounds of 11 days training programme and training
has commenced. First round of training completed in March,2017 and Second round will be
completed by September,2017

Andhra Pradesh has conducted 47 Training programs through Red Cross. The training will be completed by June, 2017 17<br>

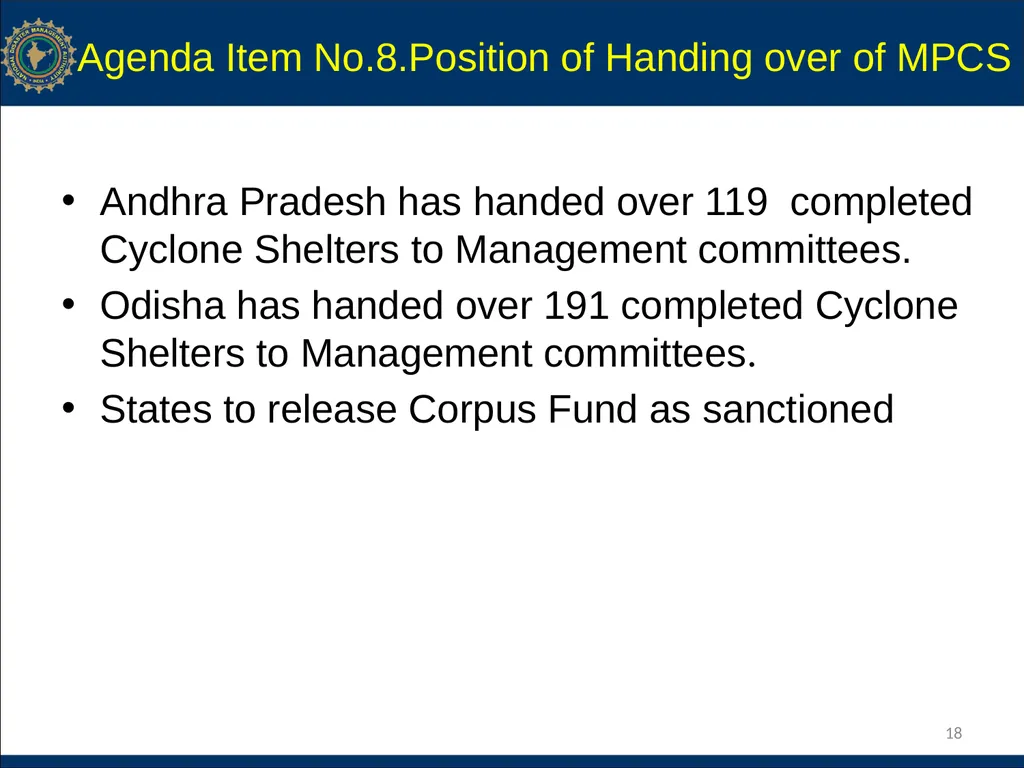

slide18. Agenda Item No.8.Position of Handing over of MPCS Andhra Pradesh has handed over 119 completed Cyclone Shelters to Management committees.
Odisha has handed over 191 completed Cyclone Shelters to Management committees.
States to release Corpus Fund as sanctioned 18<br>

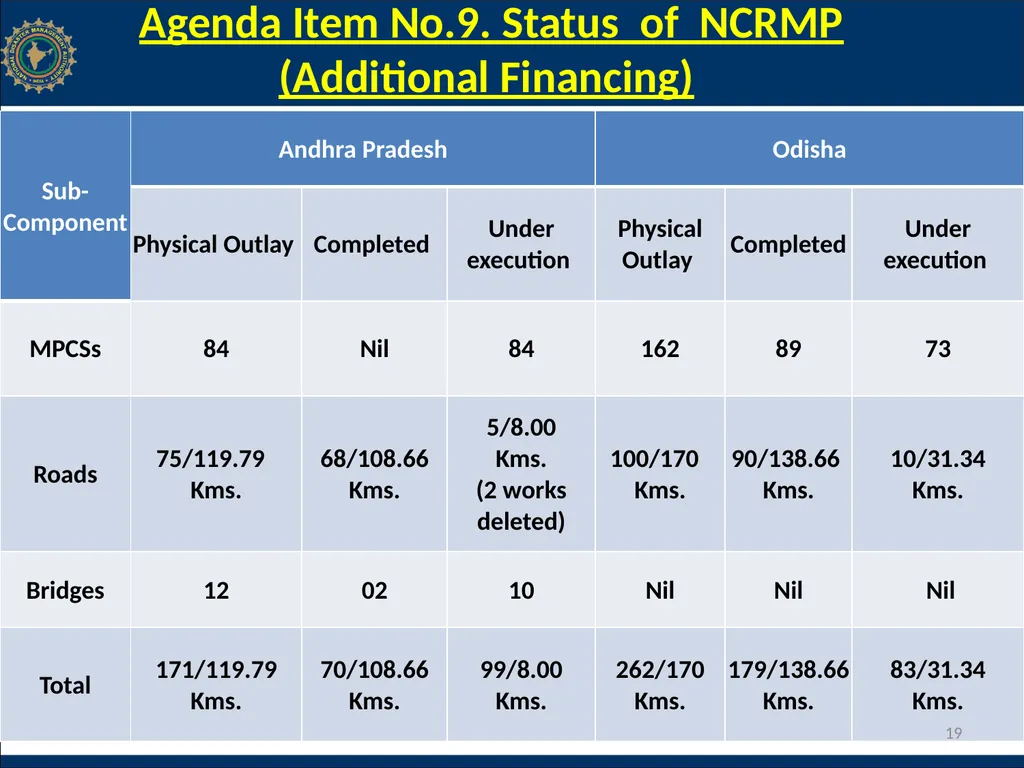

slide19. Agenda Item No.9. Status of NCRMP (Additional Financing) 19<br>
slide20. Agenda Item No.9- Compenent-B : Schedule of completion of Remaining Works AP & Odisha (Additional Financing)<br>

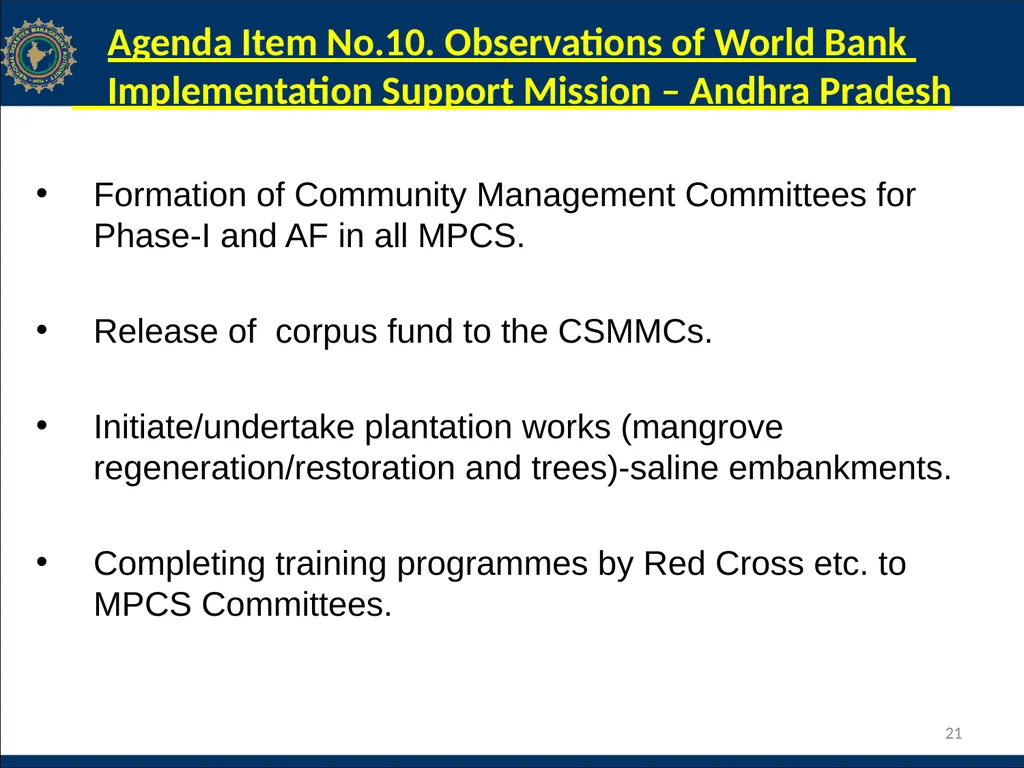

slide21. Agenda Item No.10. Observations of World Bank Implementation Support Mission – Andhra Pradesh Formation of Community Management Committees for Phase-I and AF in all MPCS.

Release of corpus fund to the CSMMCs.

Initiate/undertake plantation works (mangrove regeneration/restoration and trees)-saline embankments.

Completing training programmes by Red Cross etc. to MPCS Committees. 21<br>

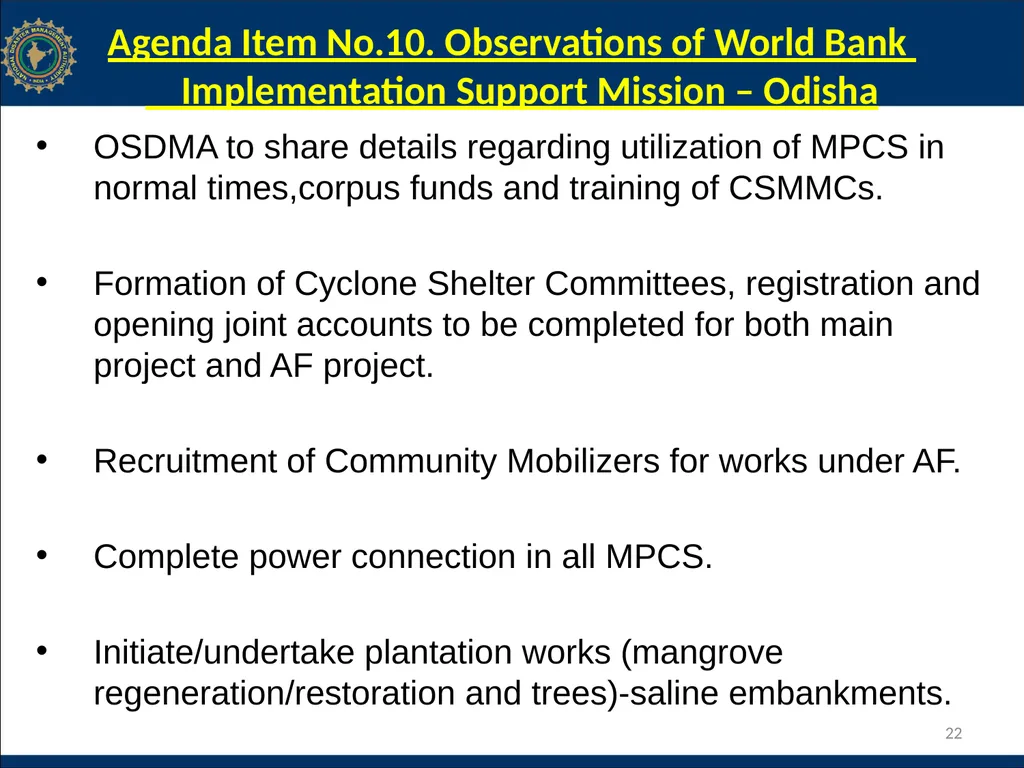

slide22. Agenda Item No.10. Observations of World Bank Implementation Support Mission – Odisha OSDMA to share details regarding utilization of MPCS in normal times,corpus funds and training of CSMMCs.

Formation of Cyclone Shelter Committees, registration and opening joint accounts to be completed for both main project and AF project.

Recruitment of Community Mobilizers for works under AF.

Complete power connection in all MPCS.

Initiate/undertake plantation works (mangrove regeneration/restoration and trees)-saline embankments. 22<br>

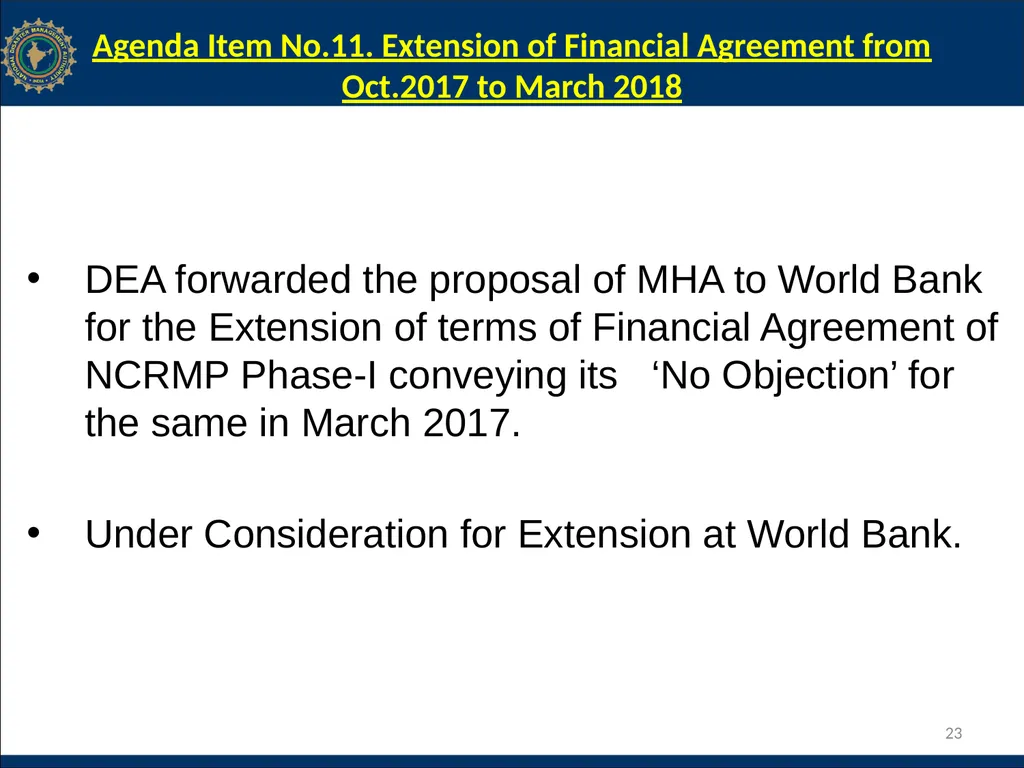

slide23. Agenda Item No.11. Extension of Financial Agreement from Oct.2017 to March 2018 DEA forwarded the proposal of MHA to World Bank for the Extension of terms of Financial Agreement of NCRMP Phase-I conveying its ‘No Objection’ for the same in March 2017.

Under Consideration for Extension at World Bank. 23<br>

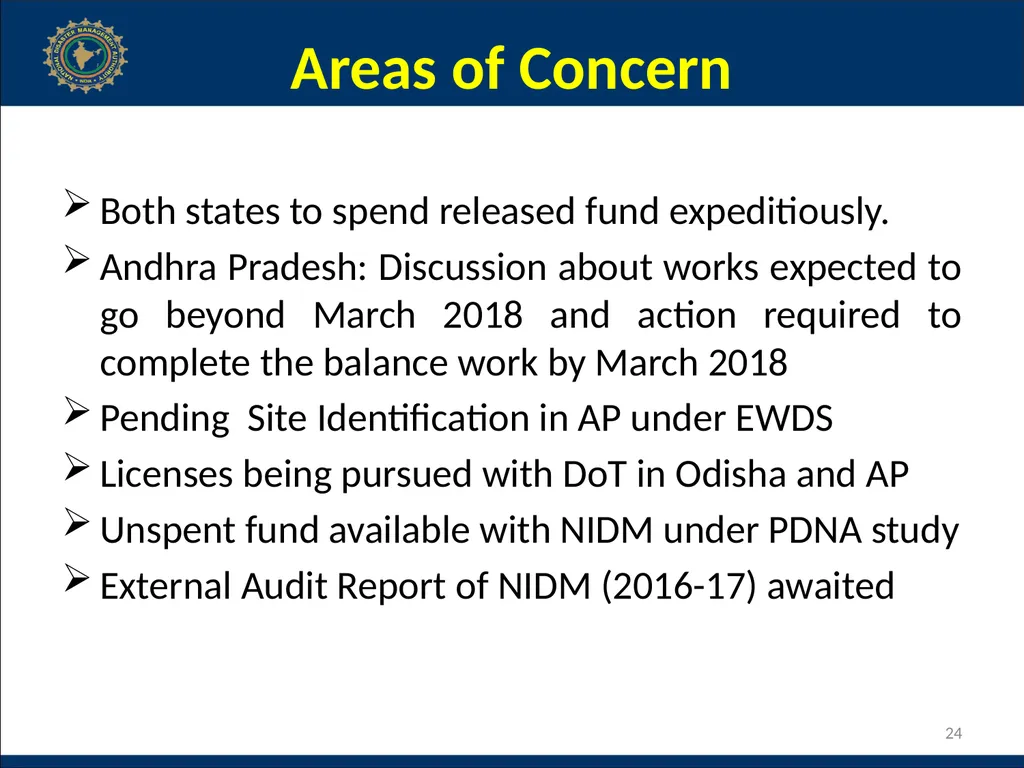

slide24. Areas of Concern Both states to spend released fund expeditiously.
Andhra Pradesh: Discussion about works expected to go beyond March 2018 and action required to complete the balance work by March 2018
Pending Site Identification in AP under EWDS
Licenses being pursued with DoT in Odisha and AP
Unspent fund available with NIDM under PDNA study
External Audit Report of NIDM (2016-17) awaited 24<br>
slide25. Thank You 25<br>

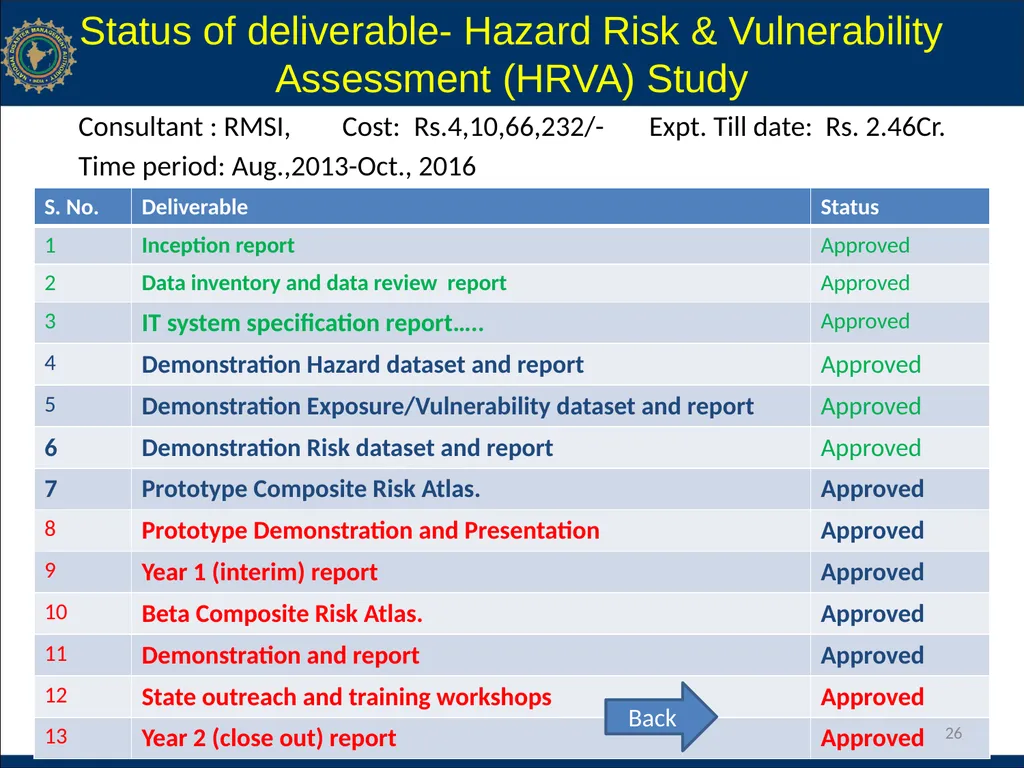

slide26. Consultant : RMSI, Cost: Rs.4,10,66,232/- Expt. Till date: Rs. 2.46Cr.
Time period: Aug.,2013-Oct., 2016 Status of deliverable- Hazard Risk & Vulnerability Assessment (HRVA) Study 26 Back<br>

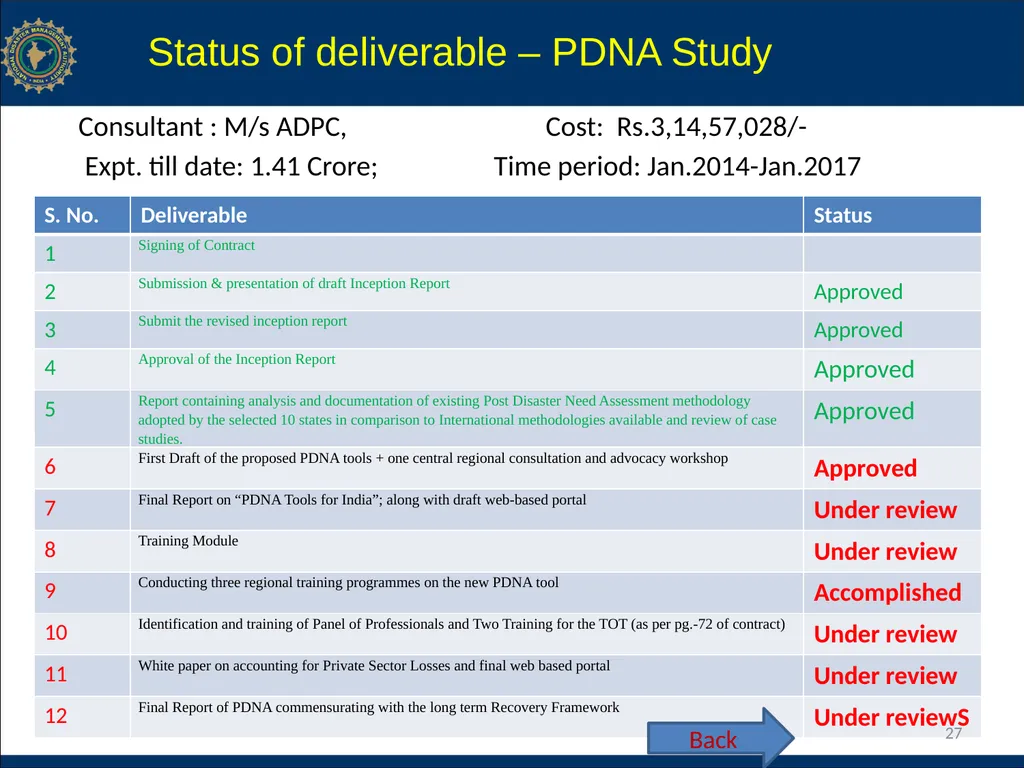

slide27. Consultant : M/s ADPC, Cost: Rs.3,14,57,028/-
Expt. till date: 1.41 Crore; Time period: Jan.2014-Jan.2017 Status of deliverable – PDNA Study 27 Back<br>

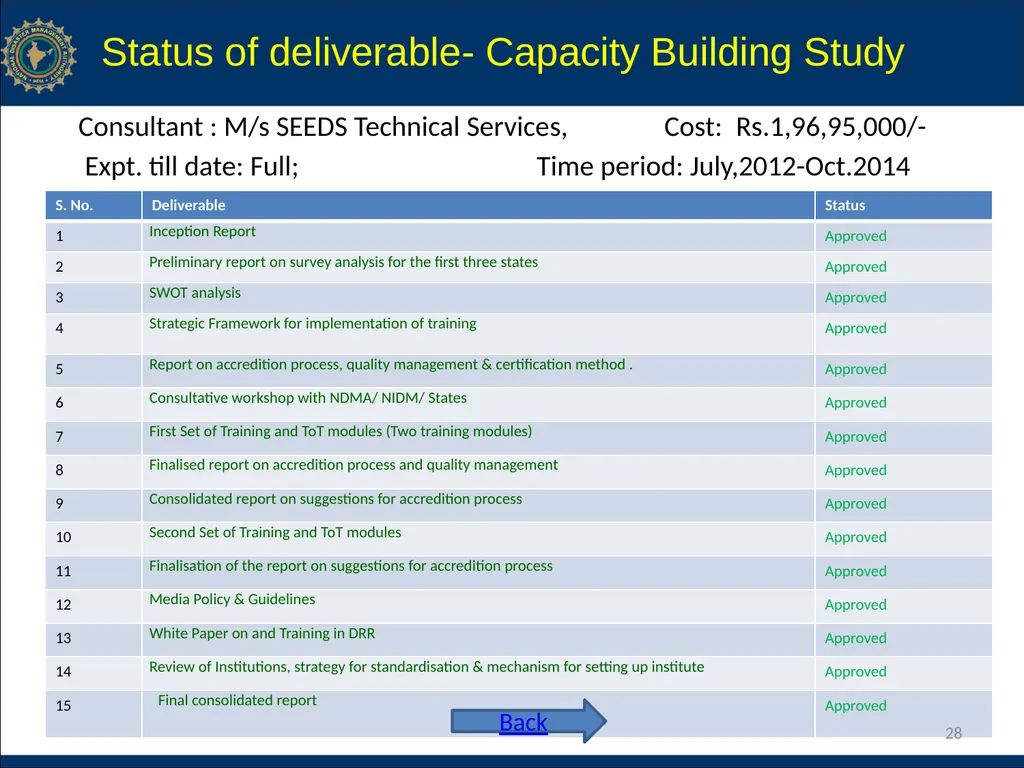

slide28. Consultant : M/s SEEDS Technical Services, Cost: Rs.1,96,95,000/-
Expt. till date: Full; Time period: July,2012-Oct.2014 Status of deliverable- Capacity Building Study 28 Back<br>

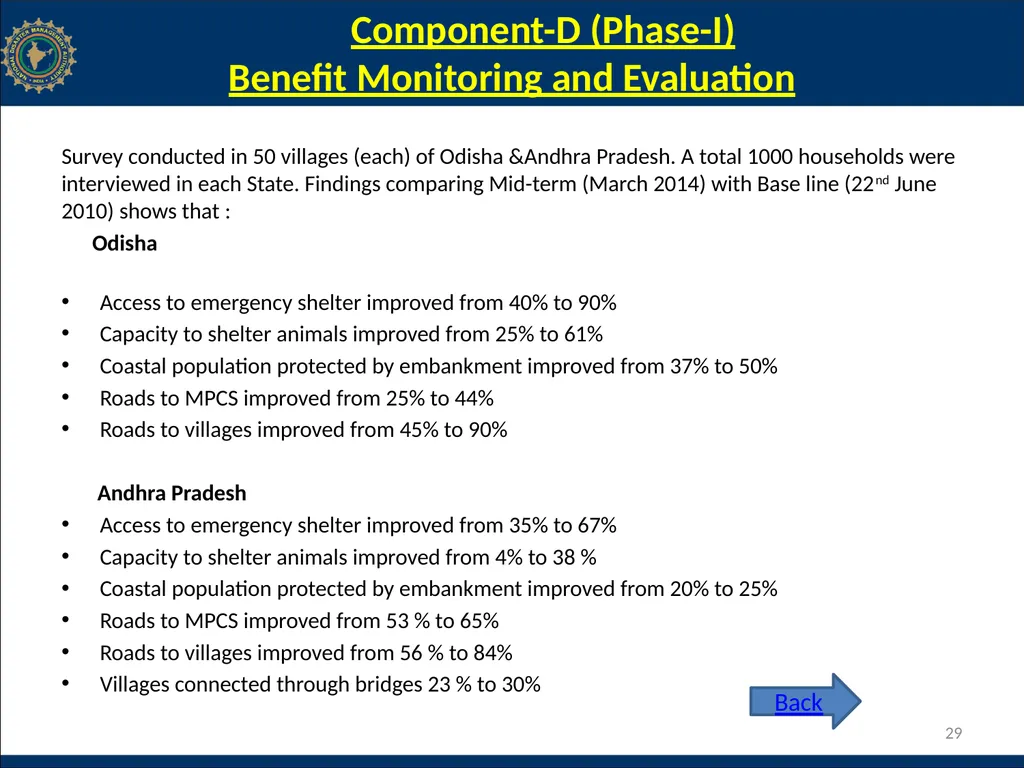

slide29. Component-D (Phase-I) Benefit Monitoring and Evaluation Survey conducted in 50 villages (each) of Odisha &Andhra Pradesh. A total 1000 households were interviewed in each State. Findings comparing Mid-term (March 2014) with Base line (22nd June 2010) shows that :
Odisha
Access to emergency shelter improved from 40% to 90%
Capacity to shelter animals improved from 25% to 61%
Coastal population protected by embankment improved from 37% to 50%
Roads to MPCS improved from 25% to 44%
Roads to villages improved from 45% to 90%

Andhra Pradesh
Access to emergency shelter improved from 35% to 67%
Capacity to shelter animals improved from 4% to 38 %
Coastal population protected by embankment improved from 20% to 25%
Roads to MPCS improved from 53 % to 65%
Roads to villages improved from 56 % to 84%
Villages connected through bridges 23 % to 30% 29 Back<br>

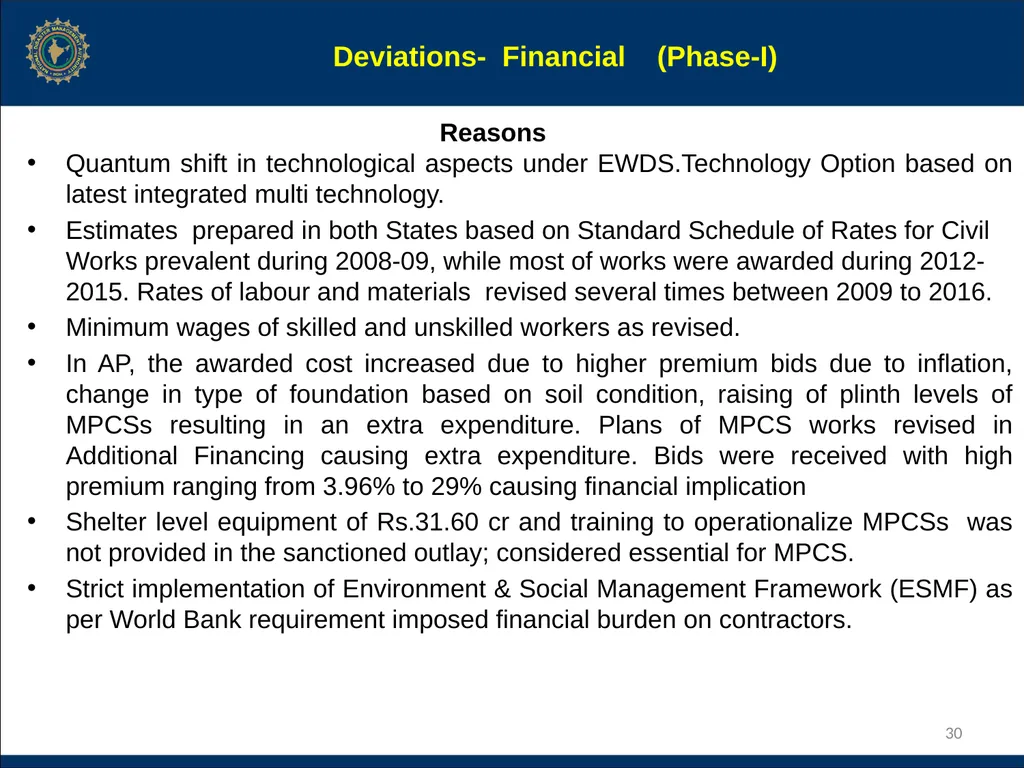

slide30. Deviations- Financial (Phase-I) Reasons
Quantum shift in technological aspects under EWDS.Technology Option based on latest integrated multi technology.
Estimates prepared in both States based on Standard Schedule of Rates for Civil Works prevalent during 2008-09, while most of works were awarded during 2012-2015. Rates of labour and materials revised several times between 2009 to 2016.
Minimum wages of skilled and unskilled workers as revised.
In AP, the awarded cost increased due to higher premium bids due to inflation, change in type of foundation based on soil condition, raising of plinth levels of MPCSs resulting in an extra expenditure. Plans of MPCS works revised in Additional Financing causing extra expenditure. Bids were received with high premium ranging from 3.96% to 29% causing financial implication
Shelter level equipment of Rs.31.60 cr and training to operationalize MPCSs was not provided in the sanctioned outlay; considered essential for MPCS.
Strict implementation of Environment & Social Management Framework (ESMF) as per World Bank requirement imposed financial burden on contractors. 30<br>
